DEAR INTERNATIONAL STUDENTS
Due to the ongoing visa issues affecting international students wishing to pursue Islamic Studies in South Africa, we are, unfortunately, unable to assist with the visa application process at this time. We pray these issues are resolved rapidly, Āmīn.
All prospective international students who manage to obtain a valid visa will be considered for admission into Our Institute.
Applications for Arabic & Islamic Studies for the 2026 academic year closes 31 October 2025 for males and 10 December 2025 for females.
Our Current Institute
Our New Institute
Development of Our New Institute

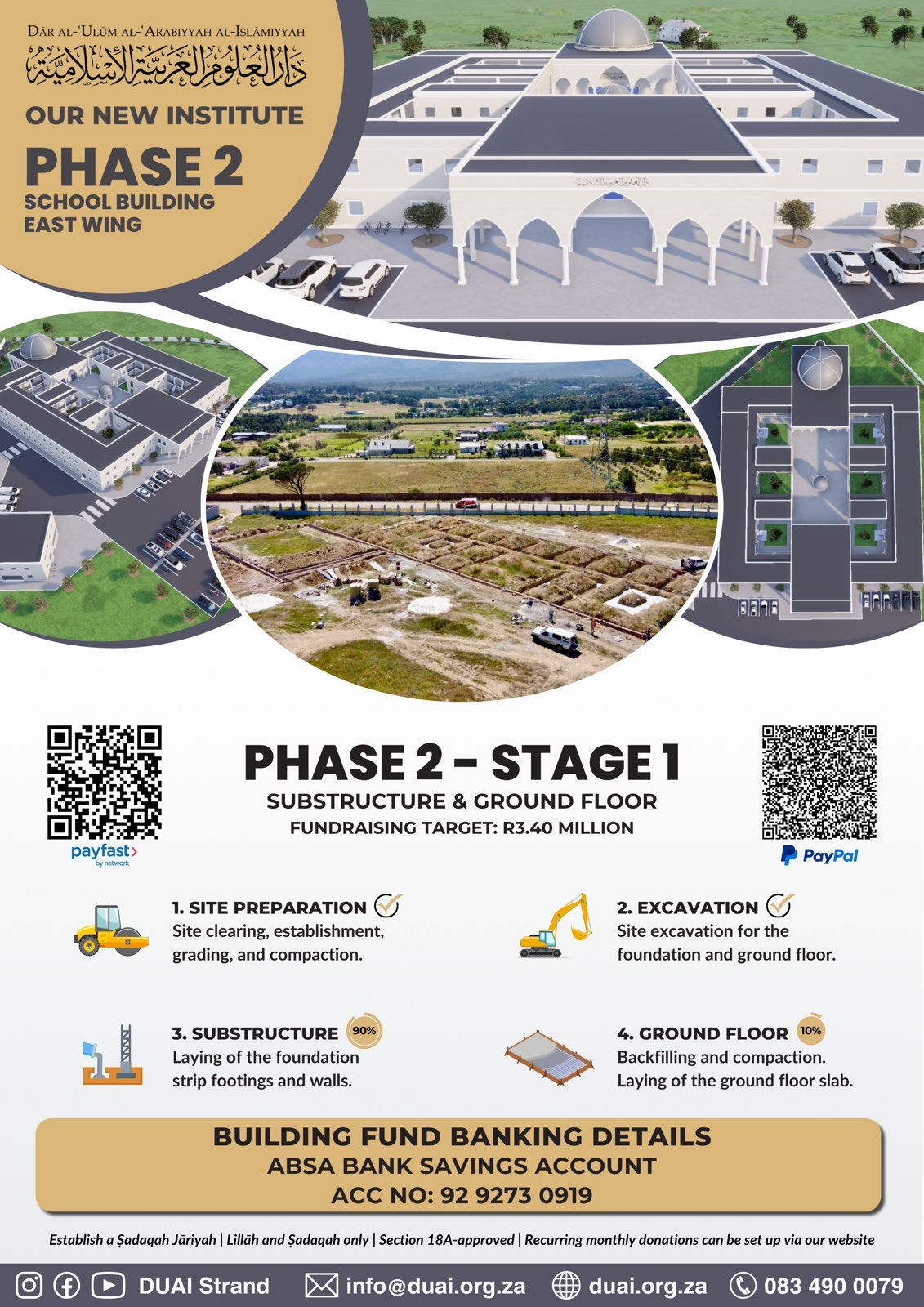

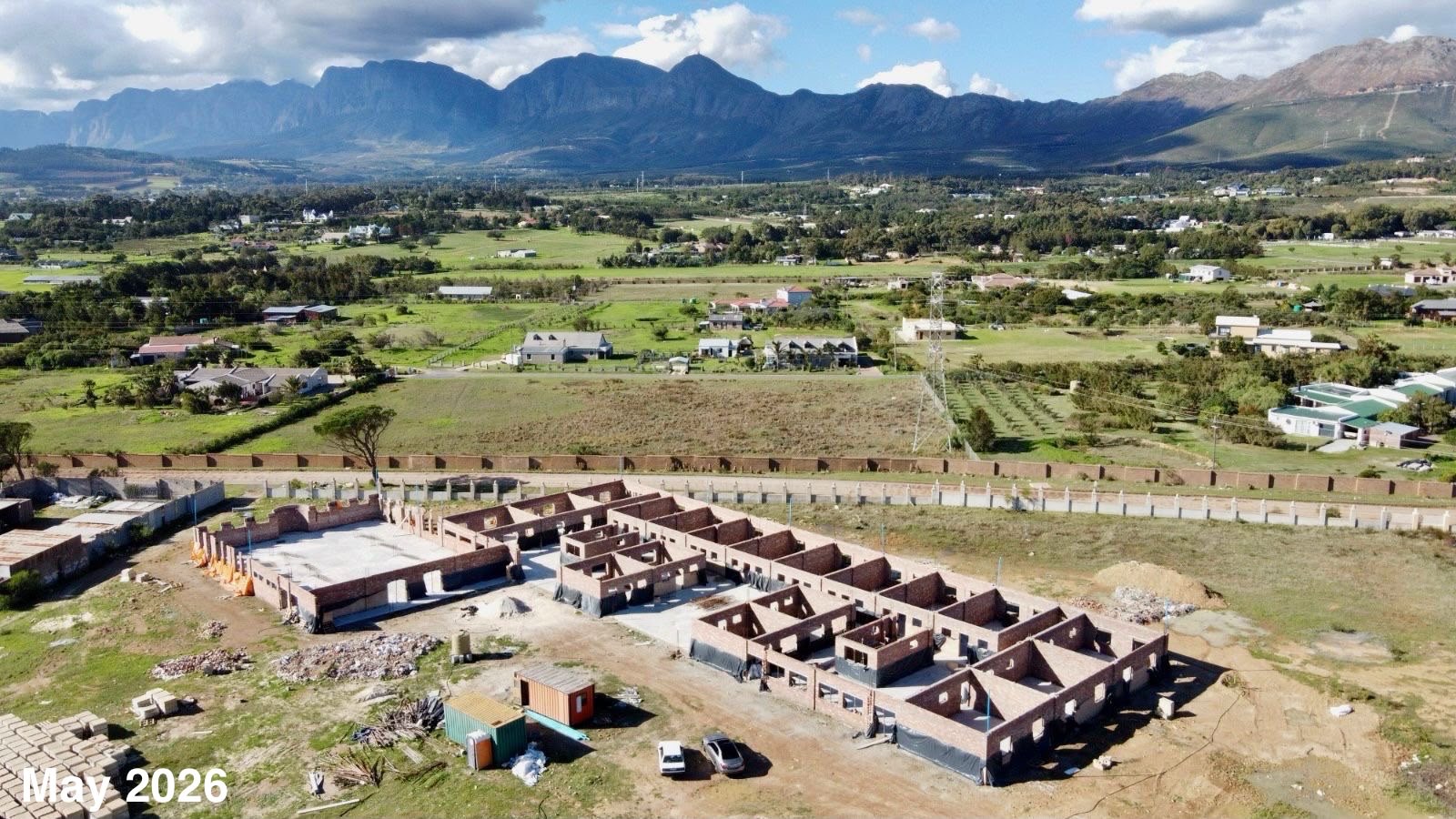

Phase 2 – Stage 1: Substructure & Ground Floor
Phase 2: School Building East Wing
Total Funds Invested in Project
* As at 1 December 2025
Work Completed

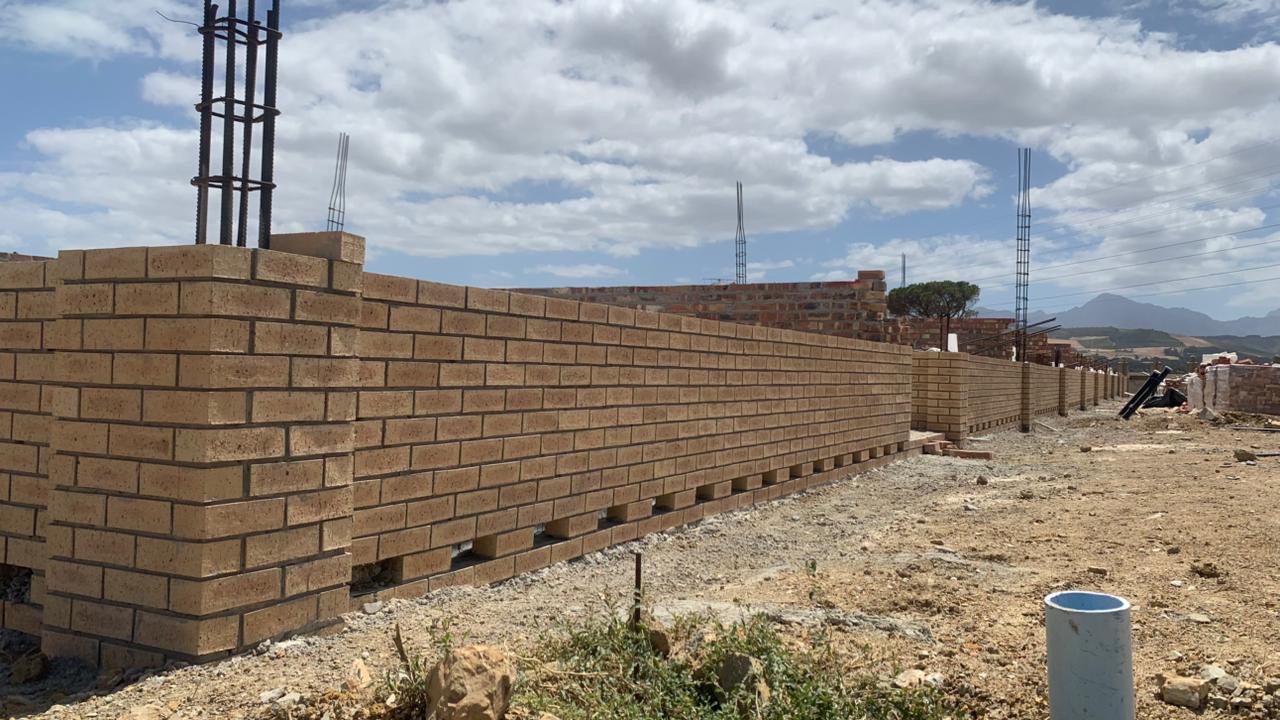

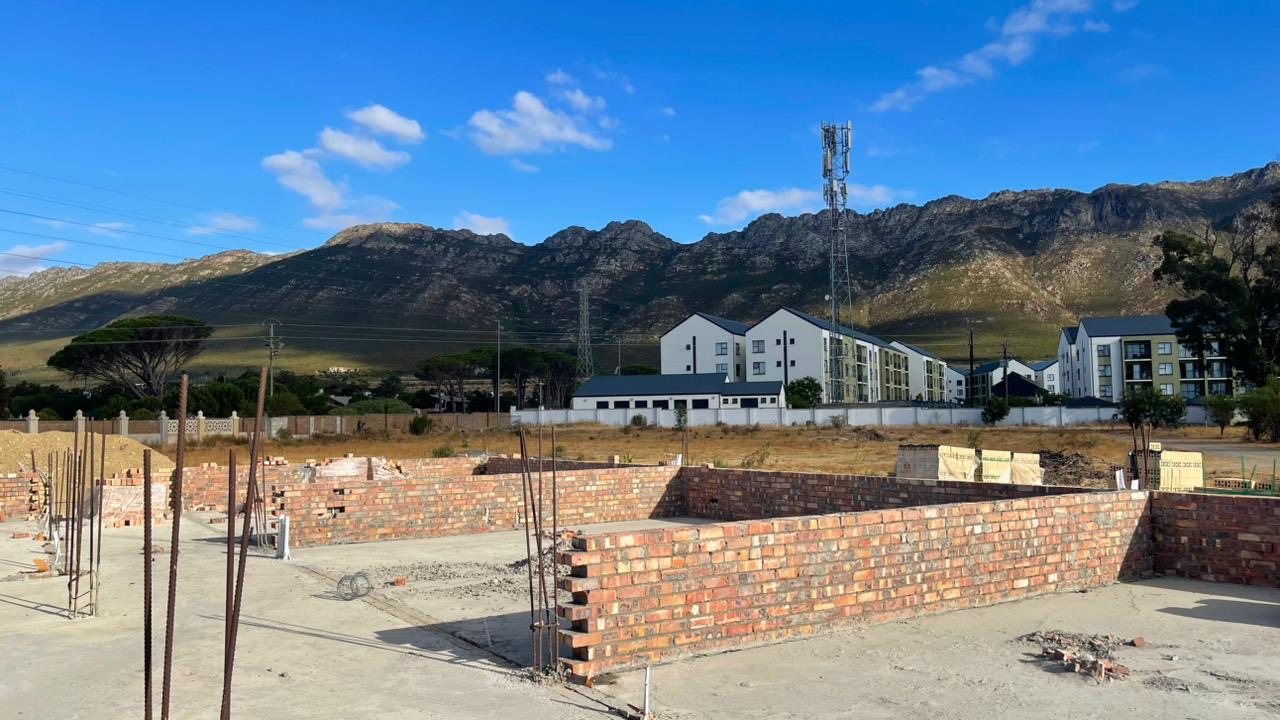

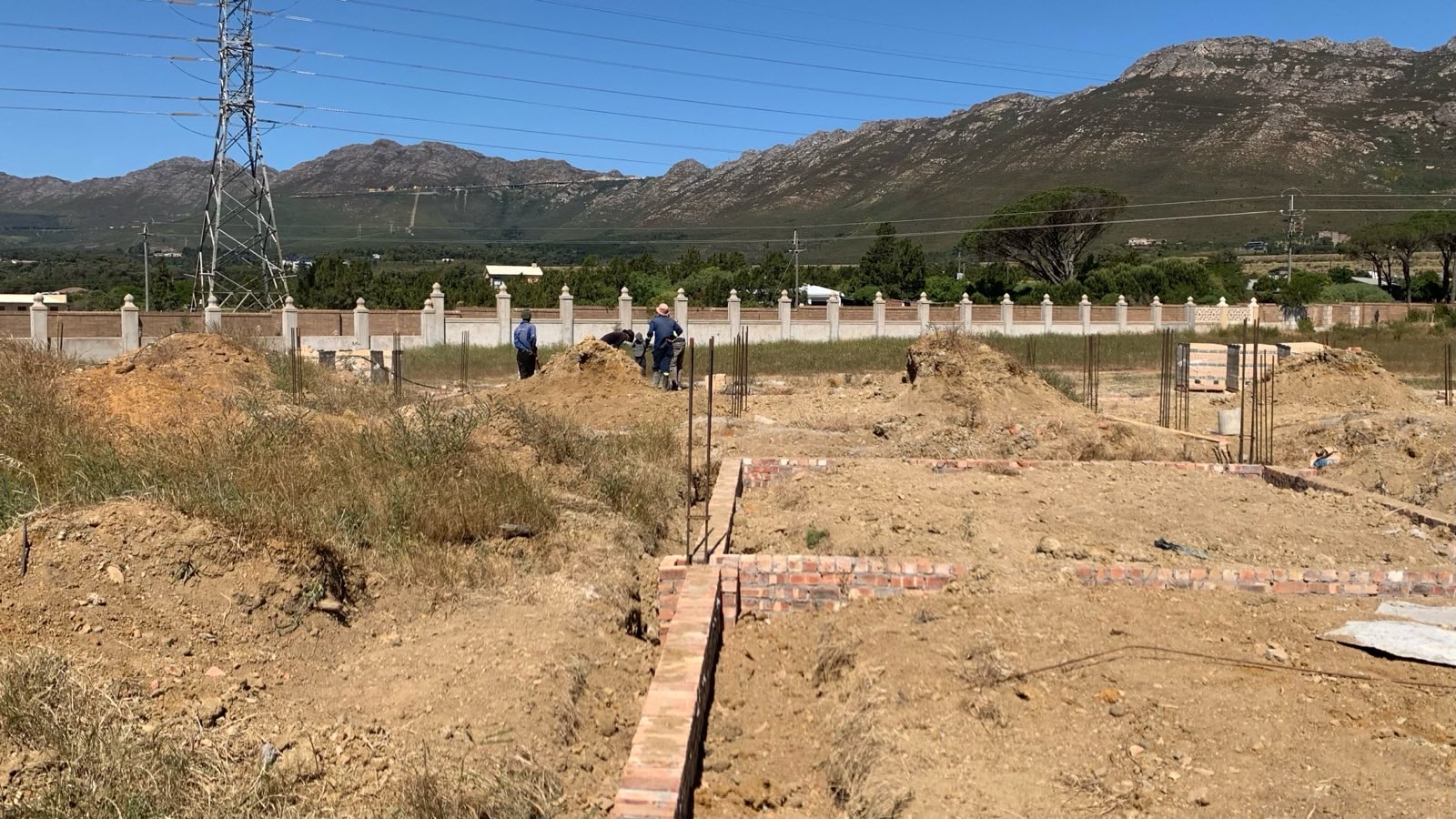

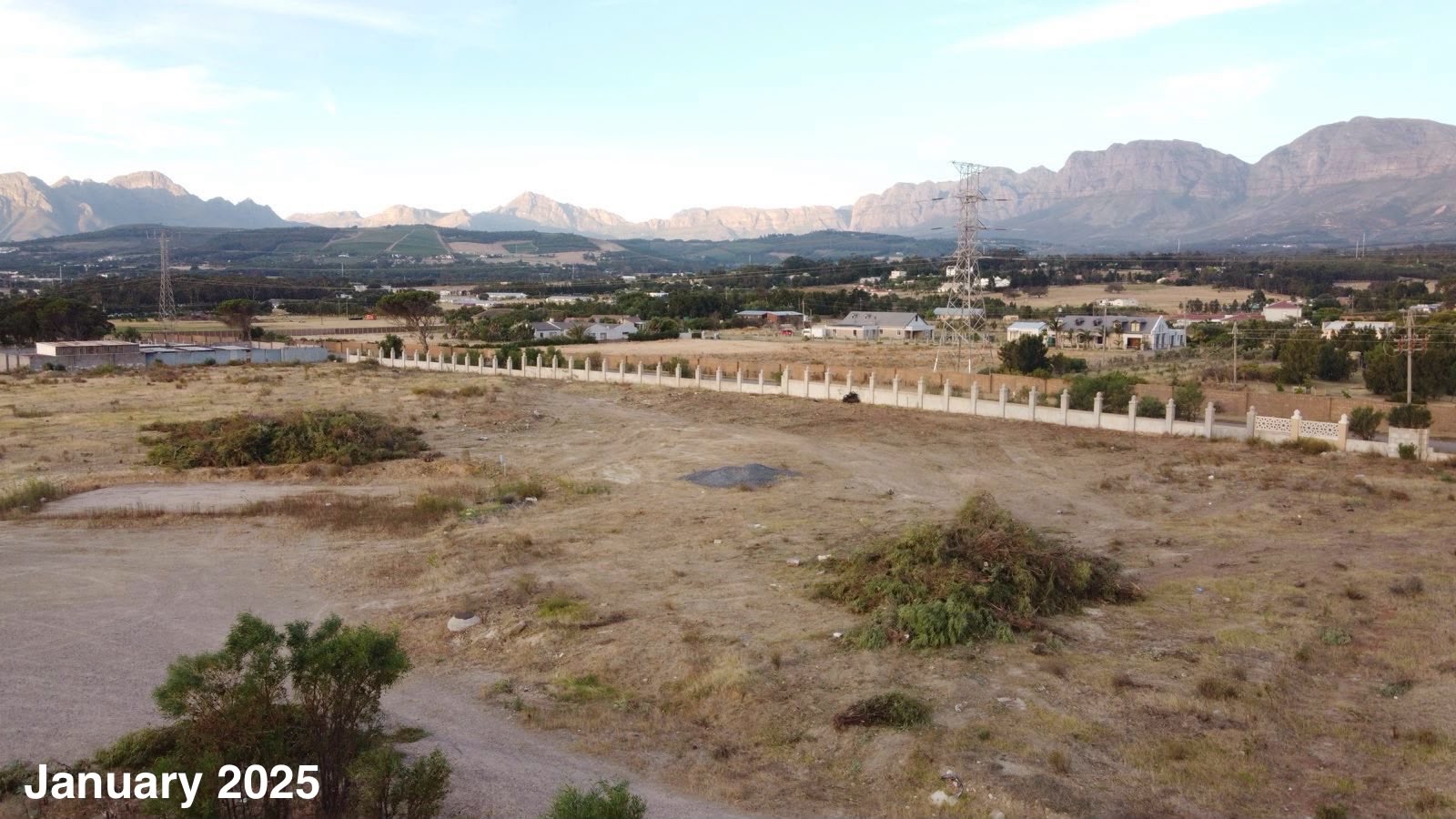

AlḥamduliLlāh, our building plan has been approved by council, which concluded Phase 1 (the pre-construction phase) of the project. As part of Phase 1, the land was acquired, rezoned, and the development contribution and scrutiny fees paid. Majority of the initial and underground civil work was also completed, which included site preparation, bulk earthworks, and the installation of water, stormwater, sewerage, and cabling networks. Majority of the front boundary wall has also been built and the rear fencing erected. We have also developed the electrical plans.

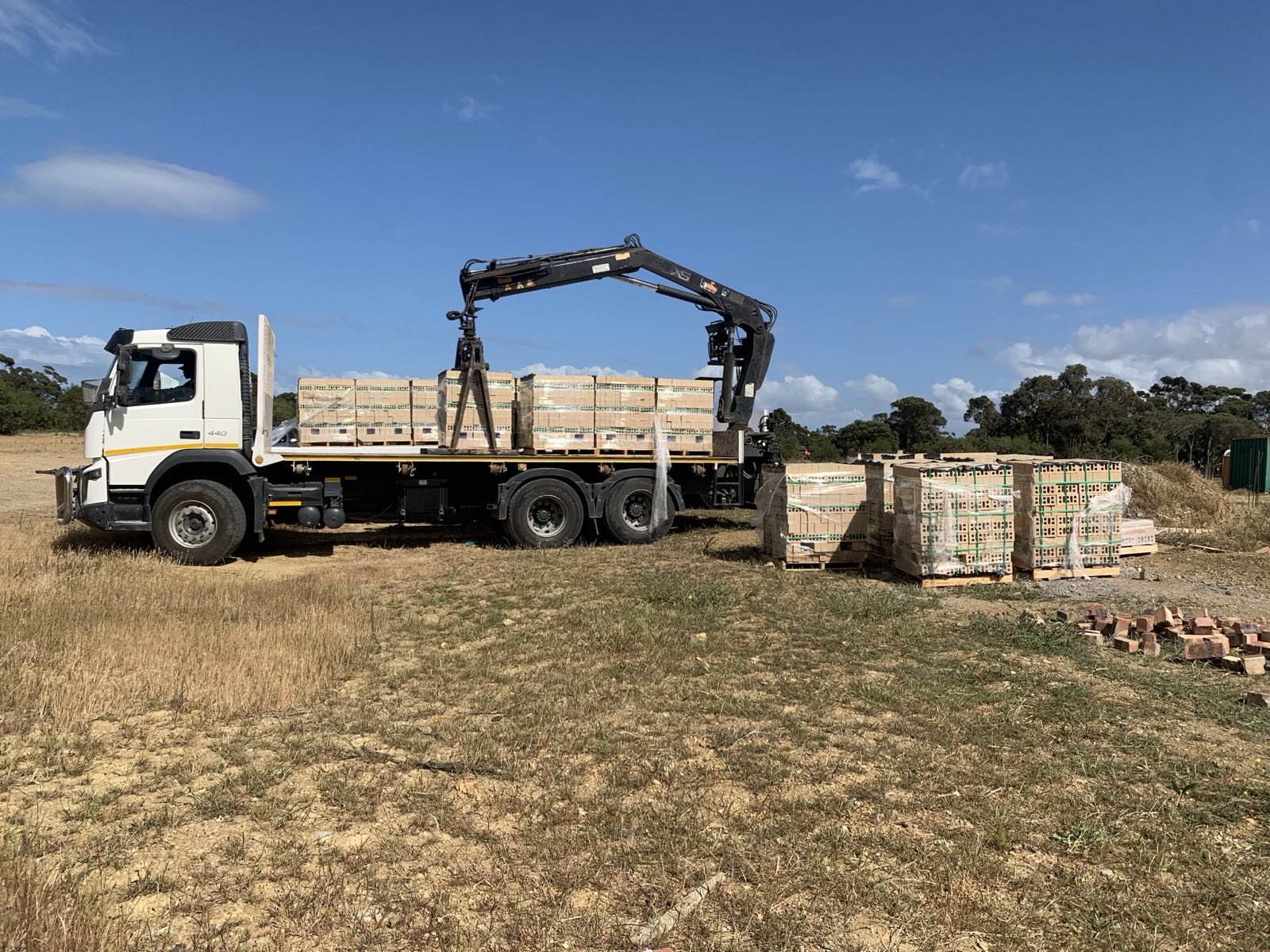

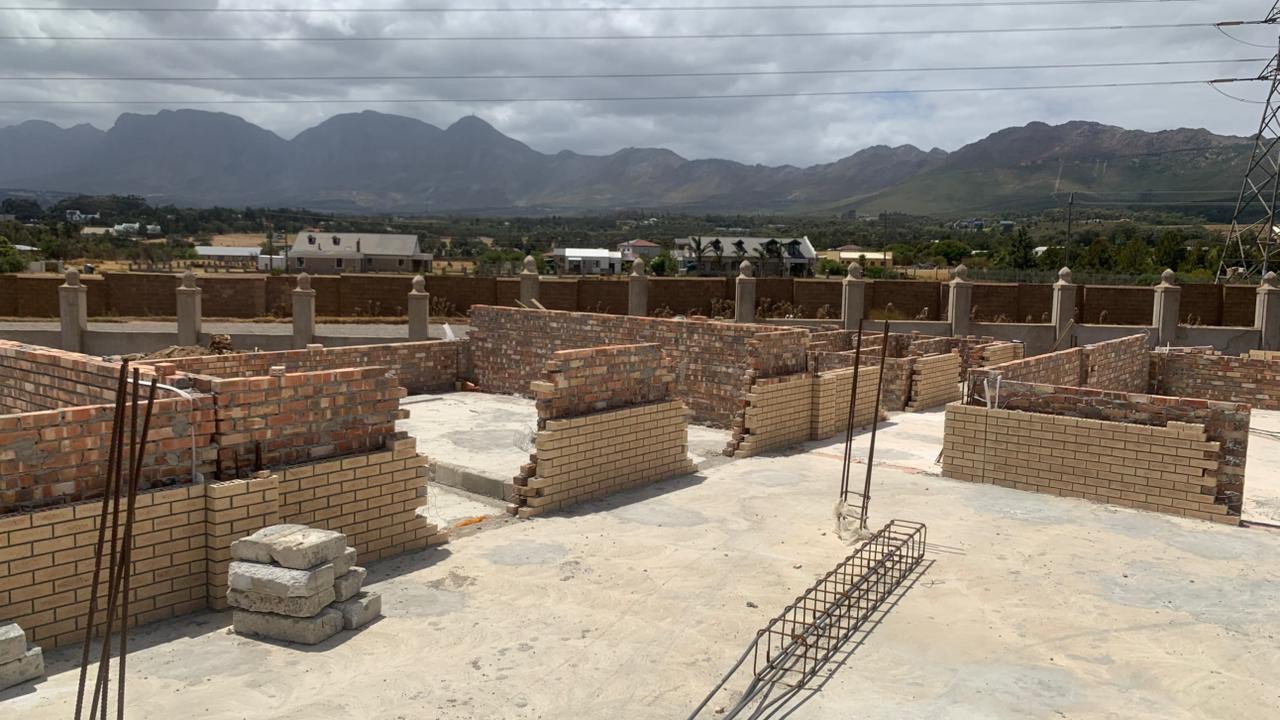

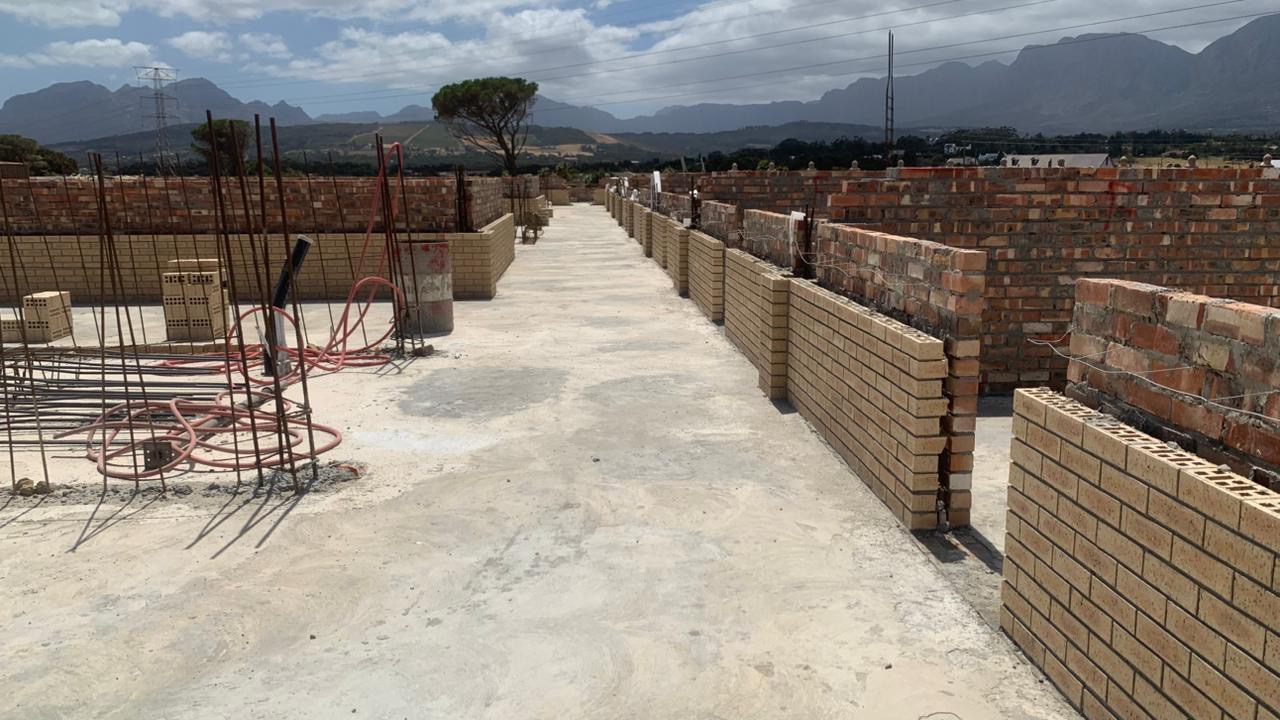

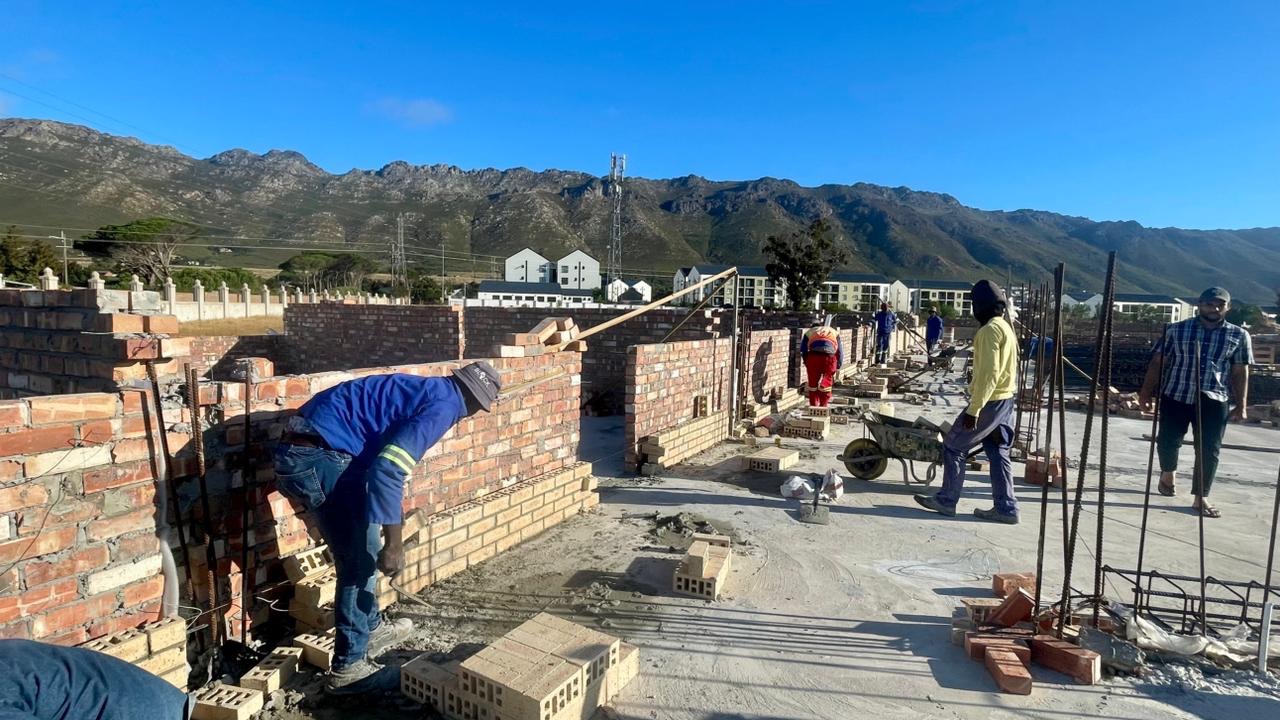

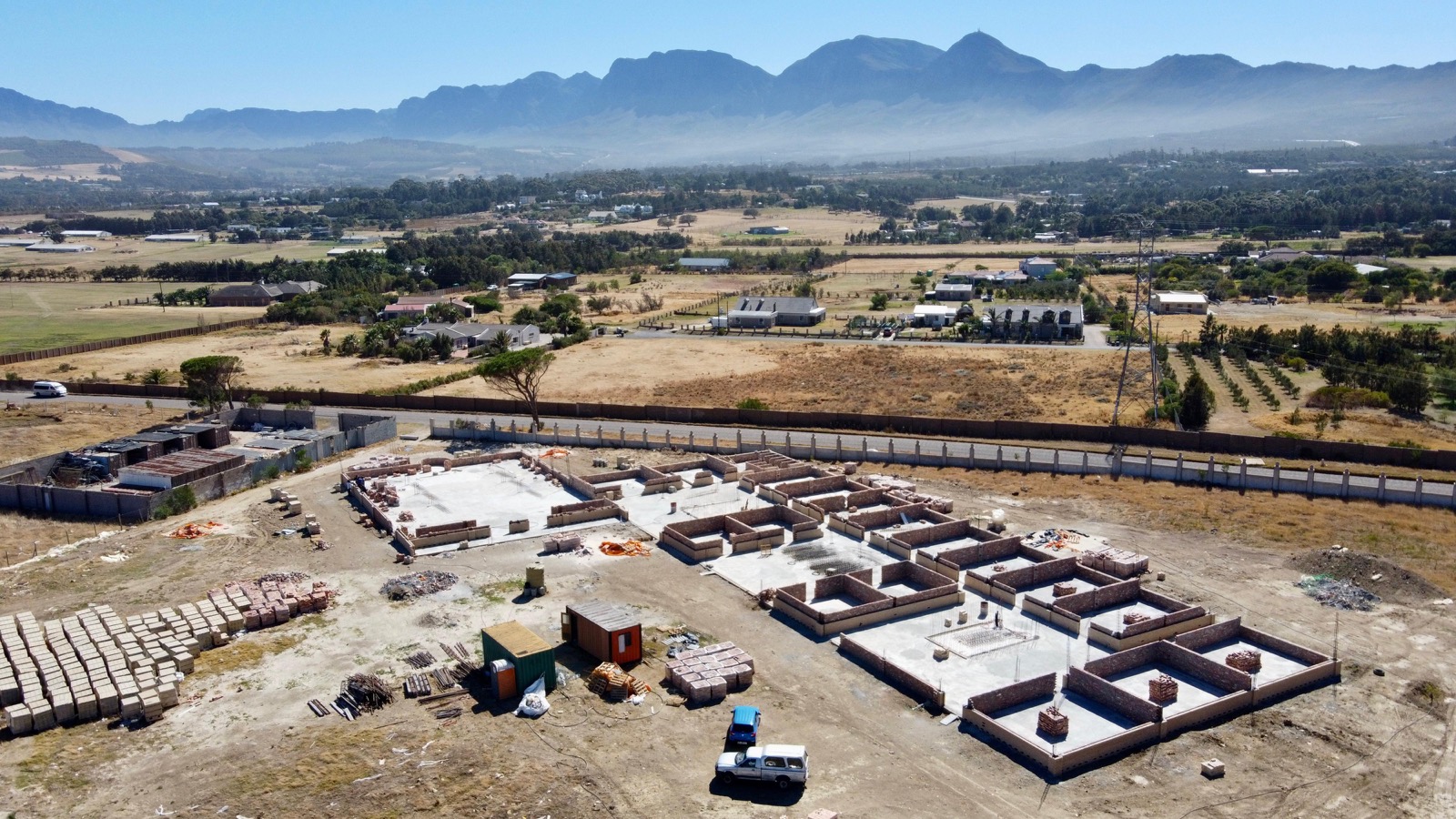

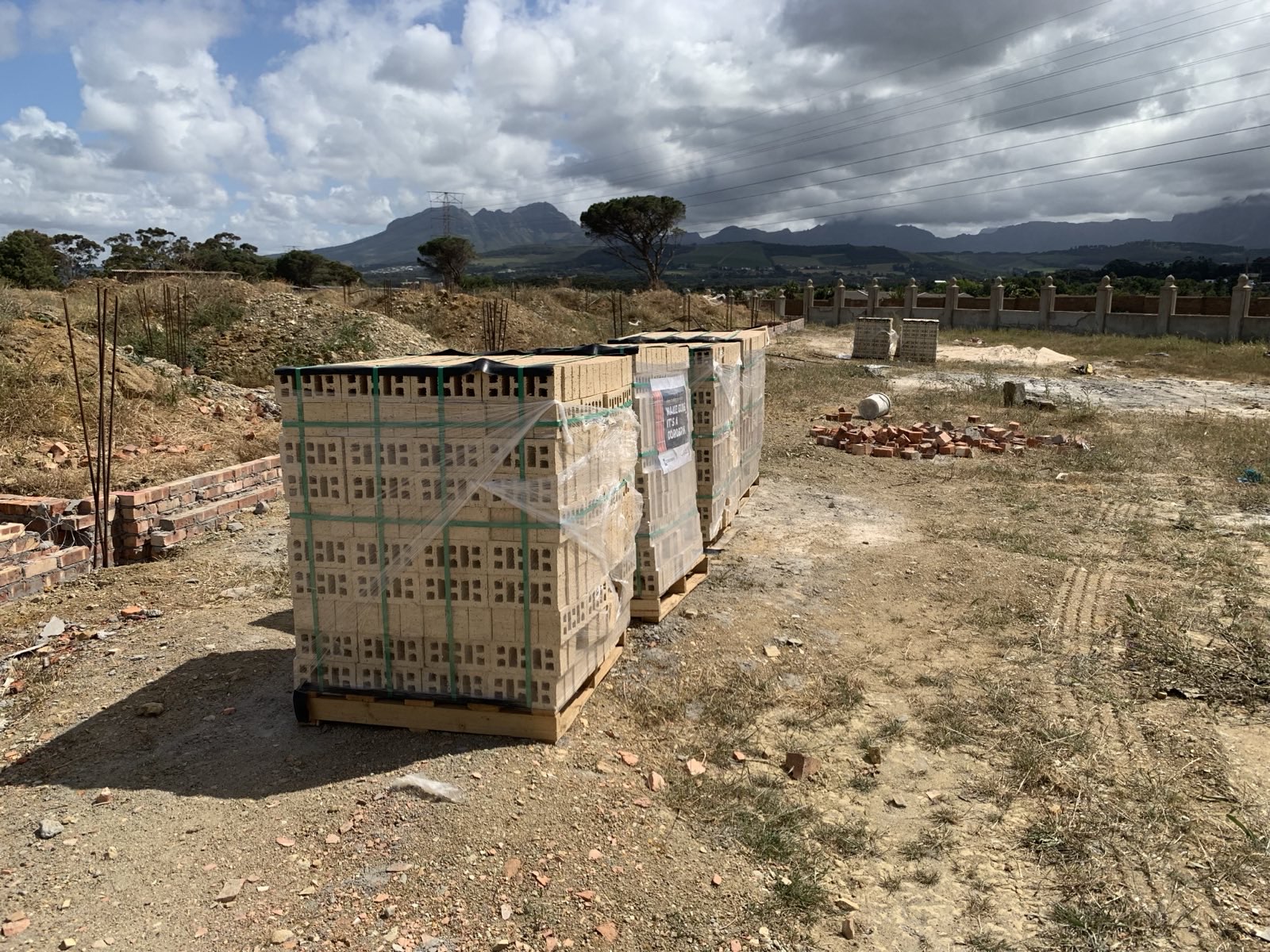

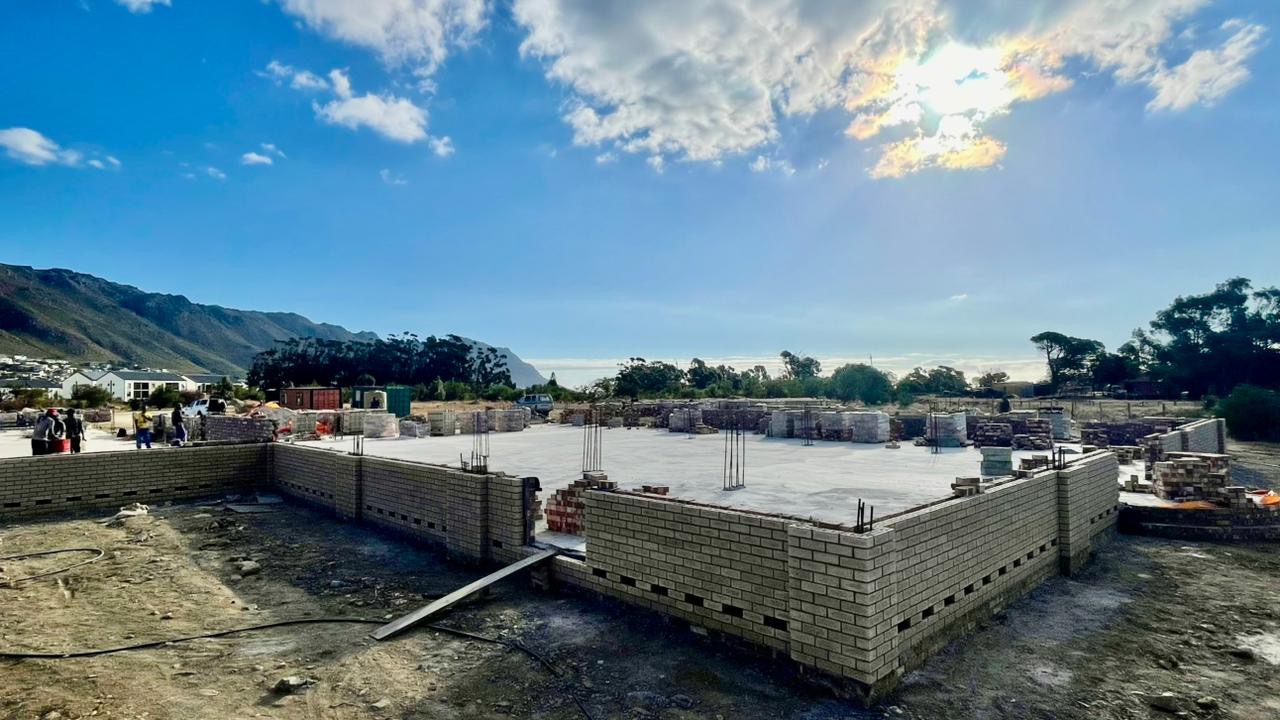

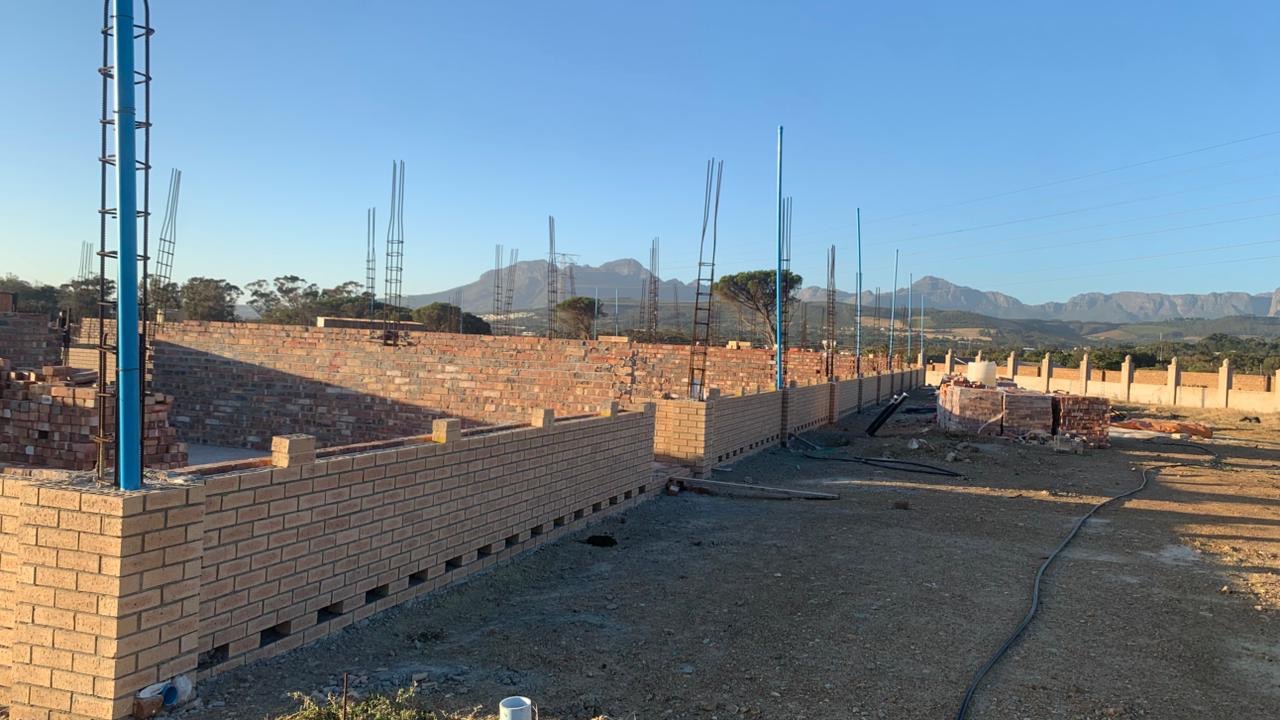

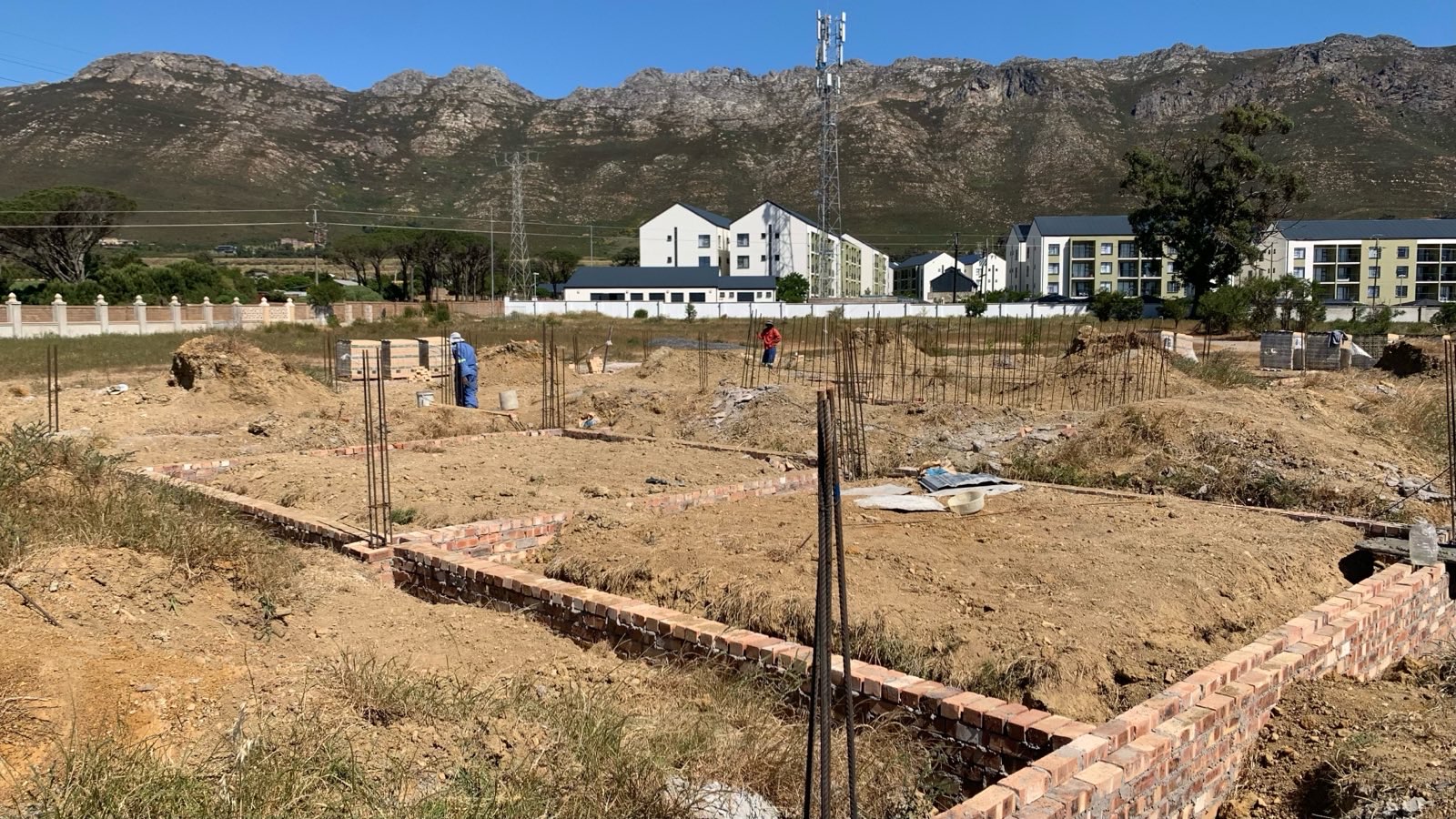

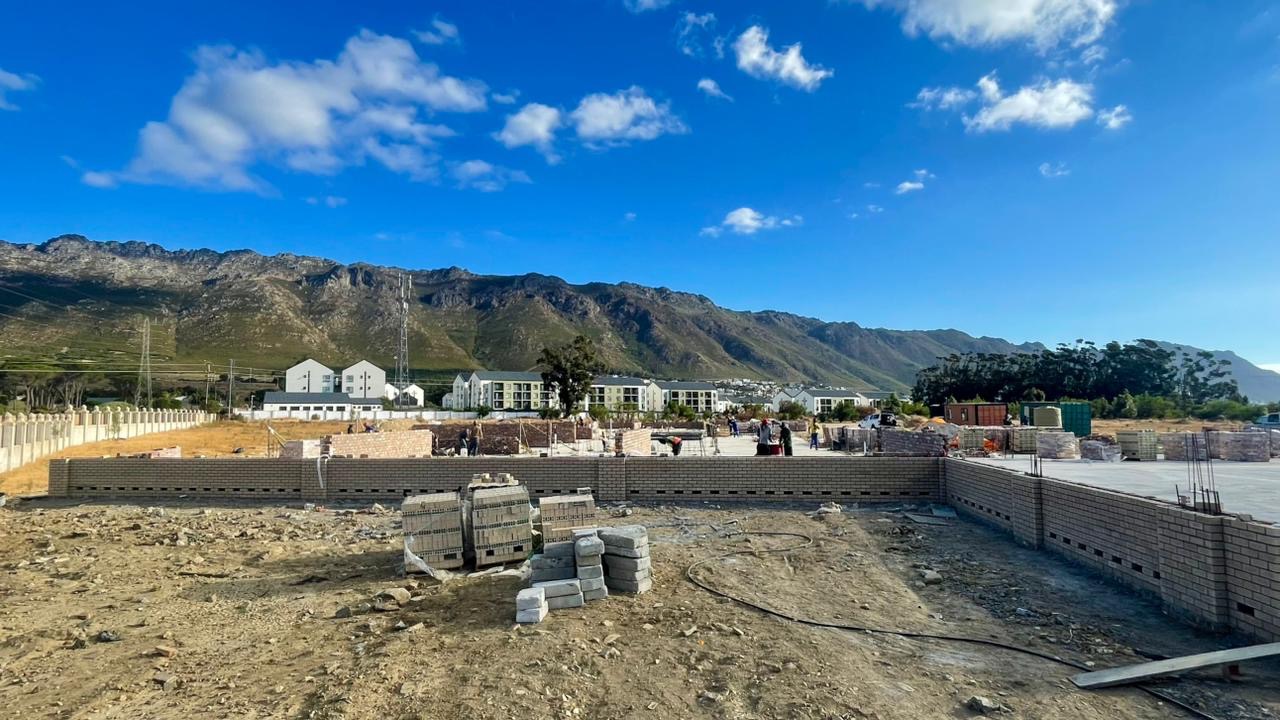

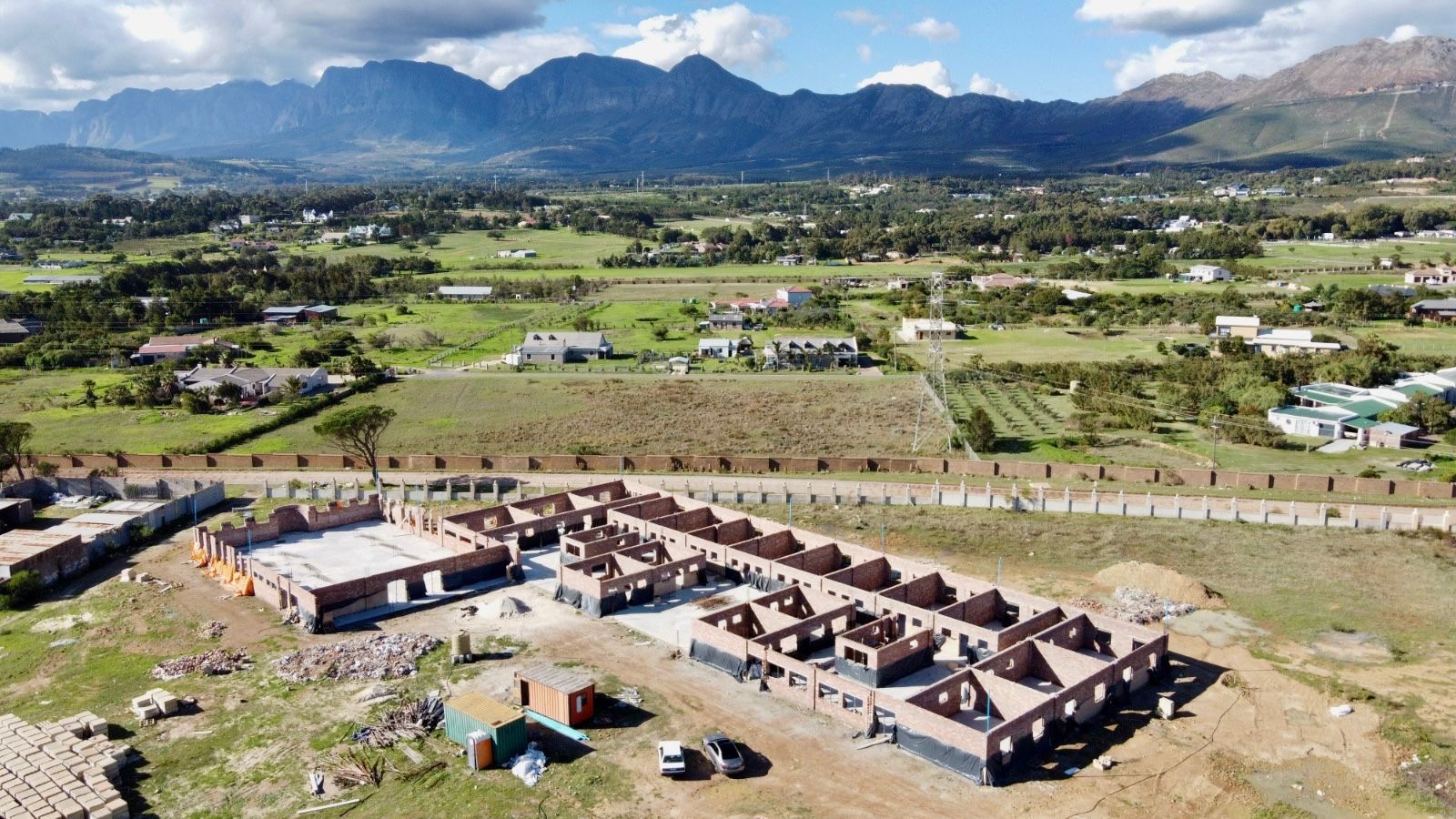

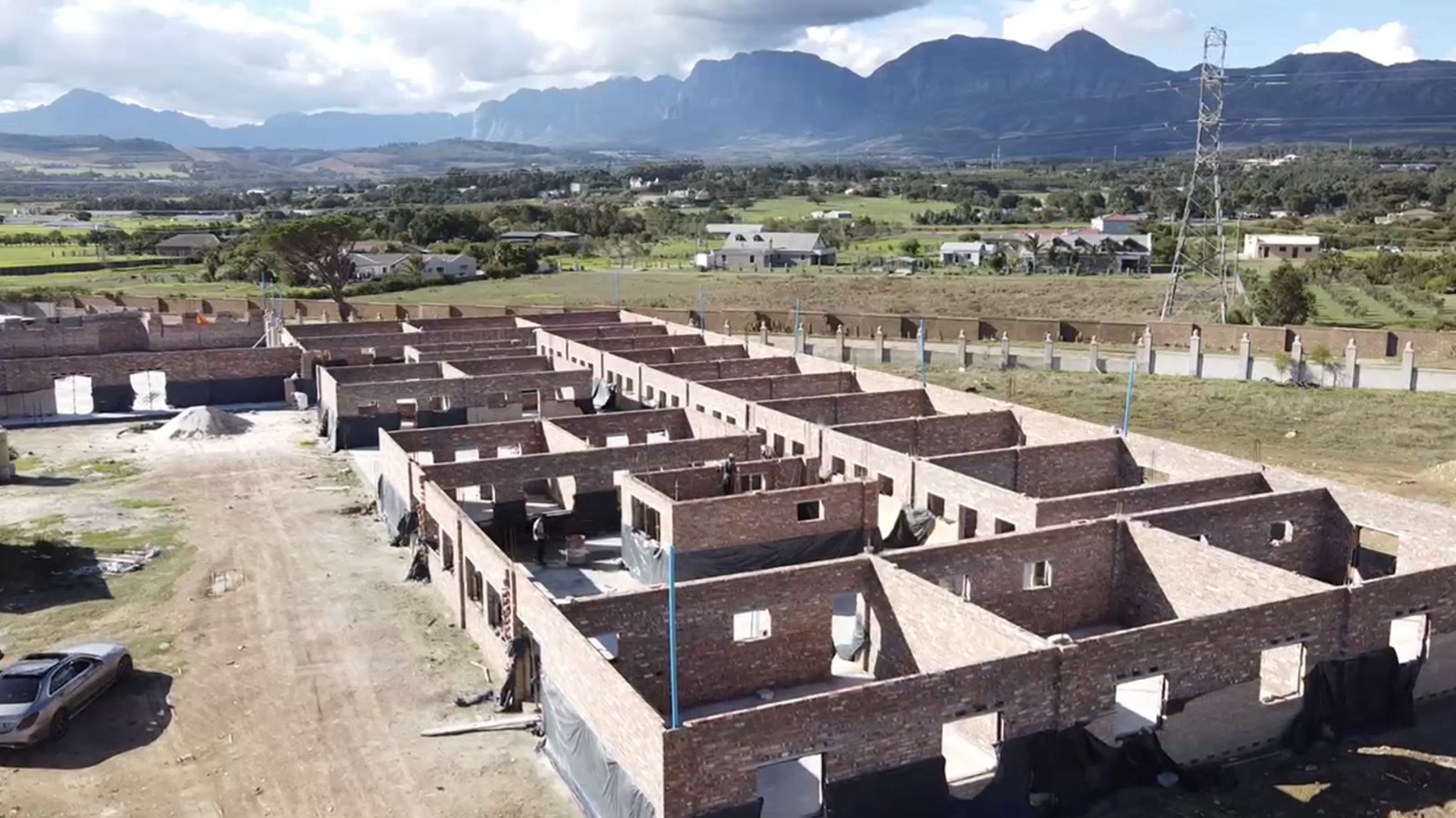

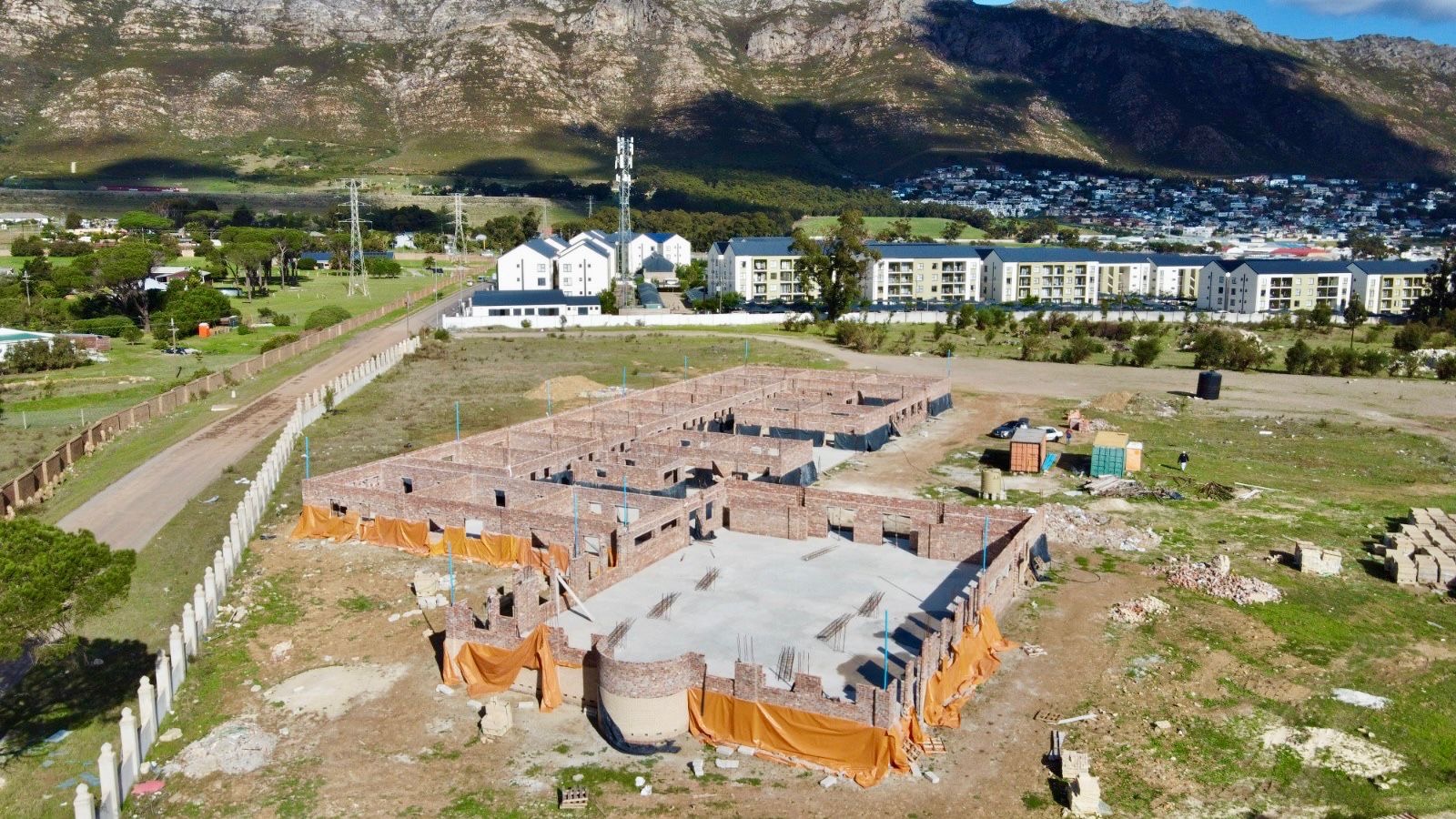

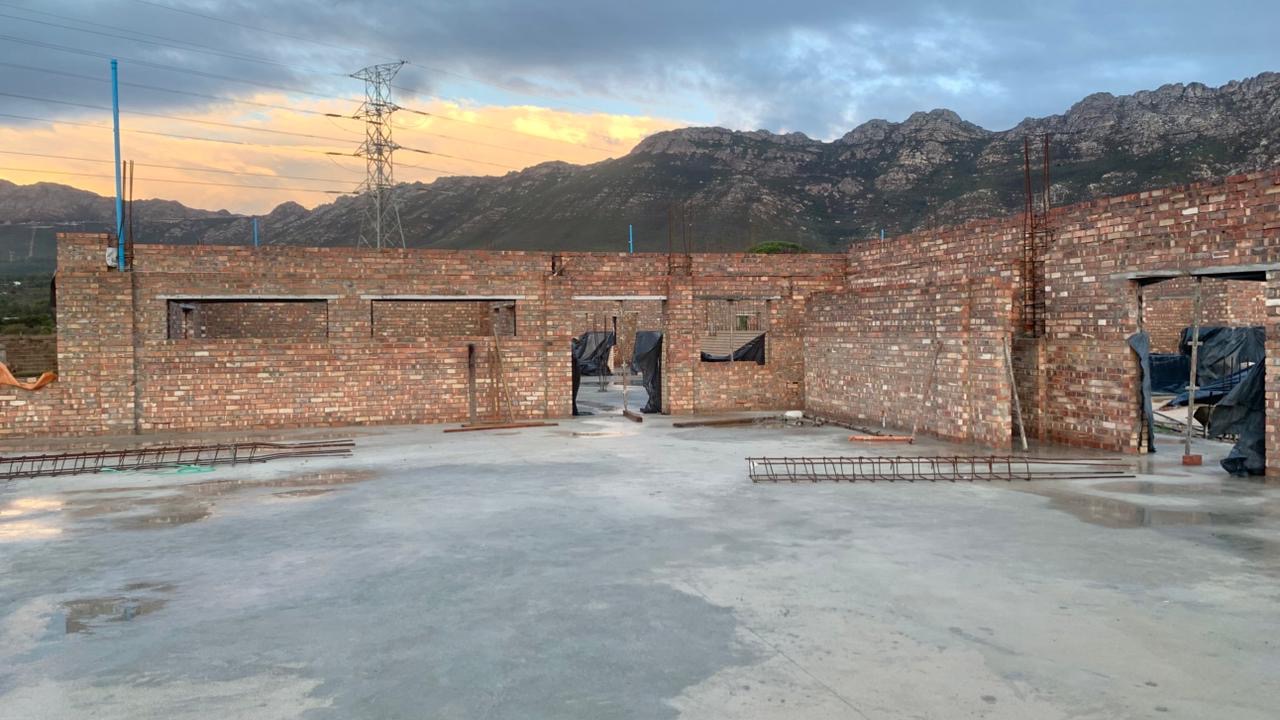

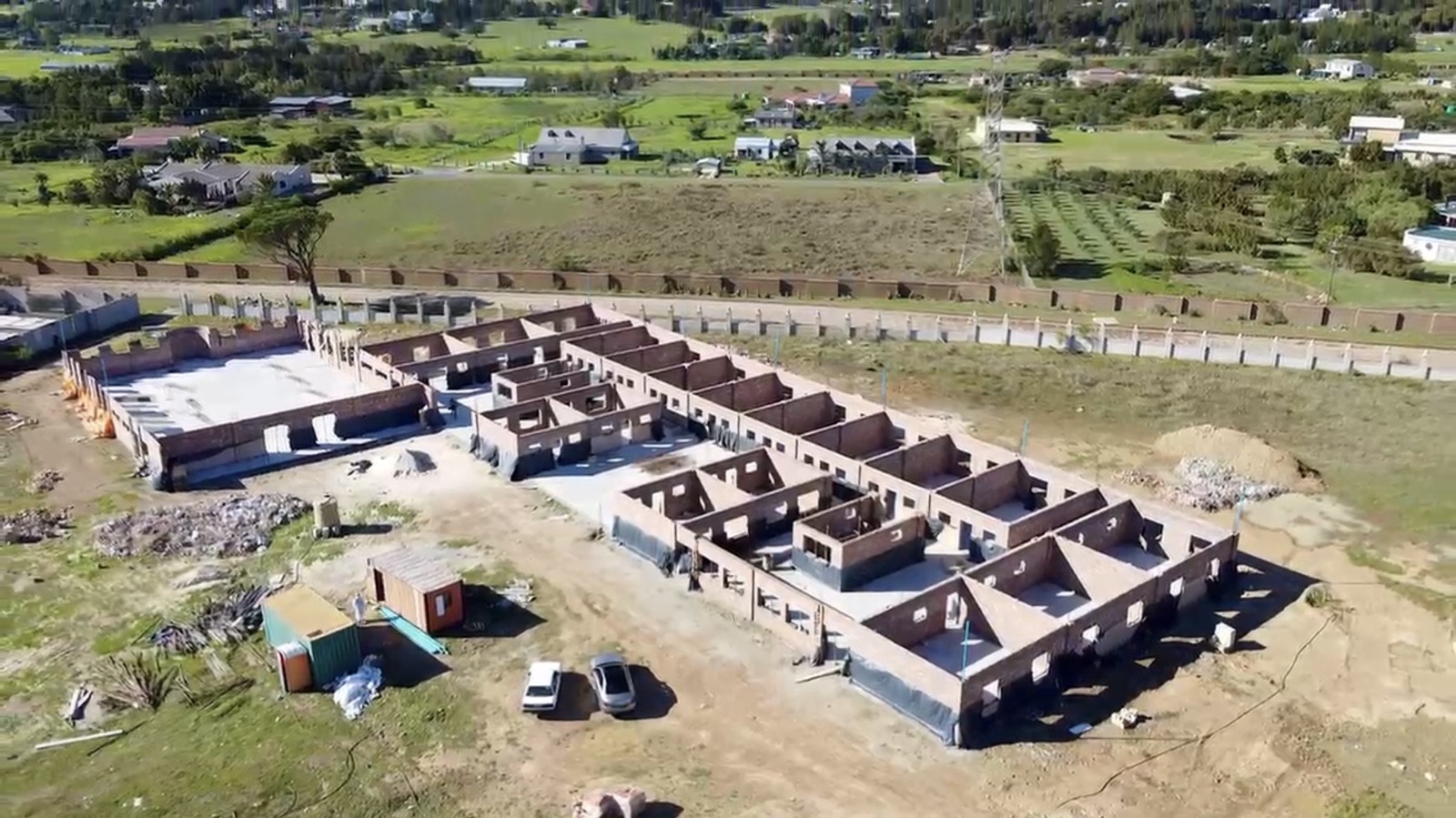

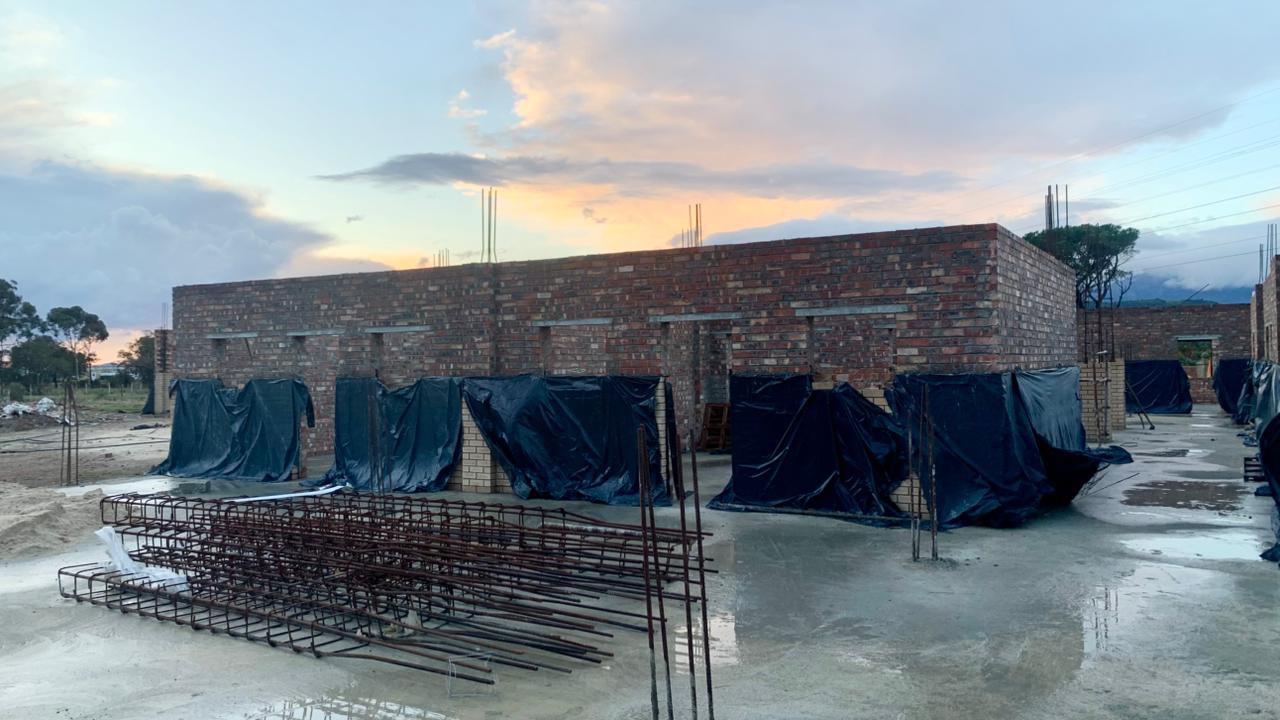

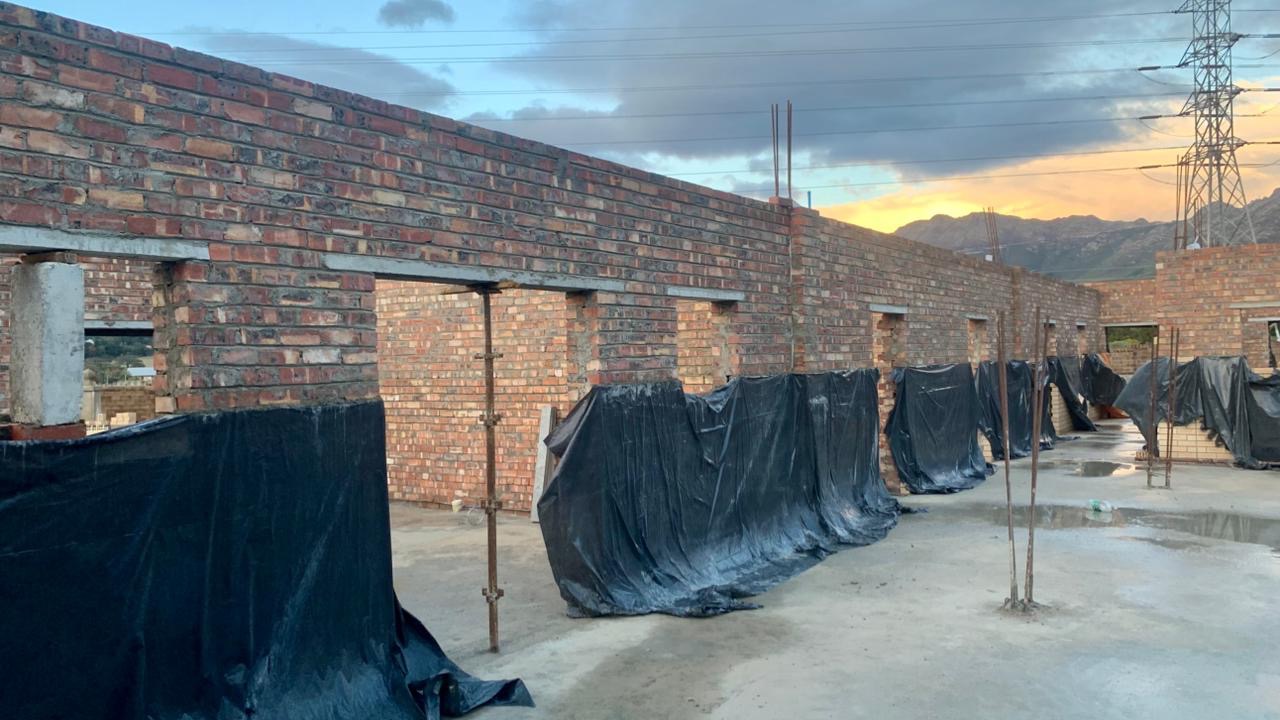

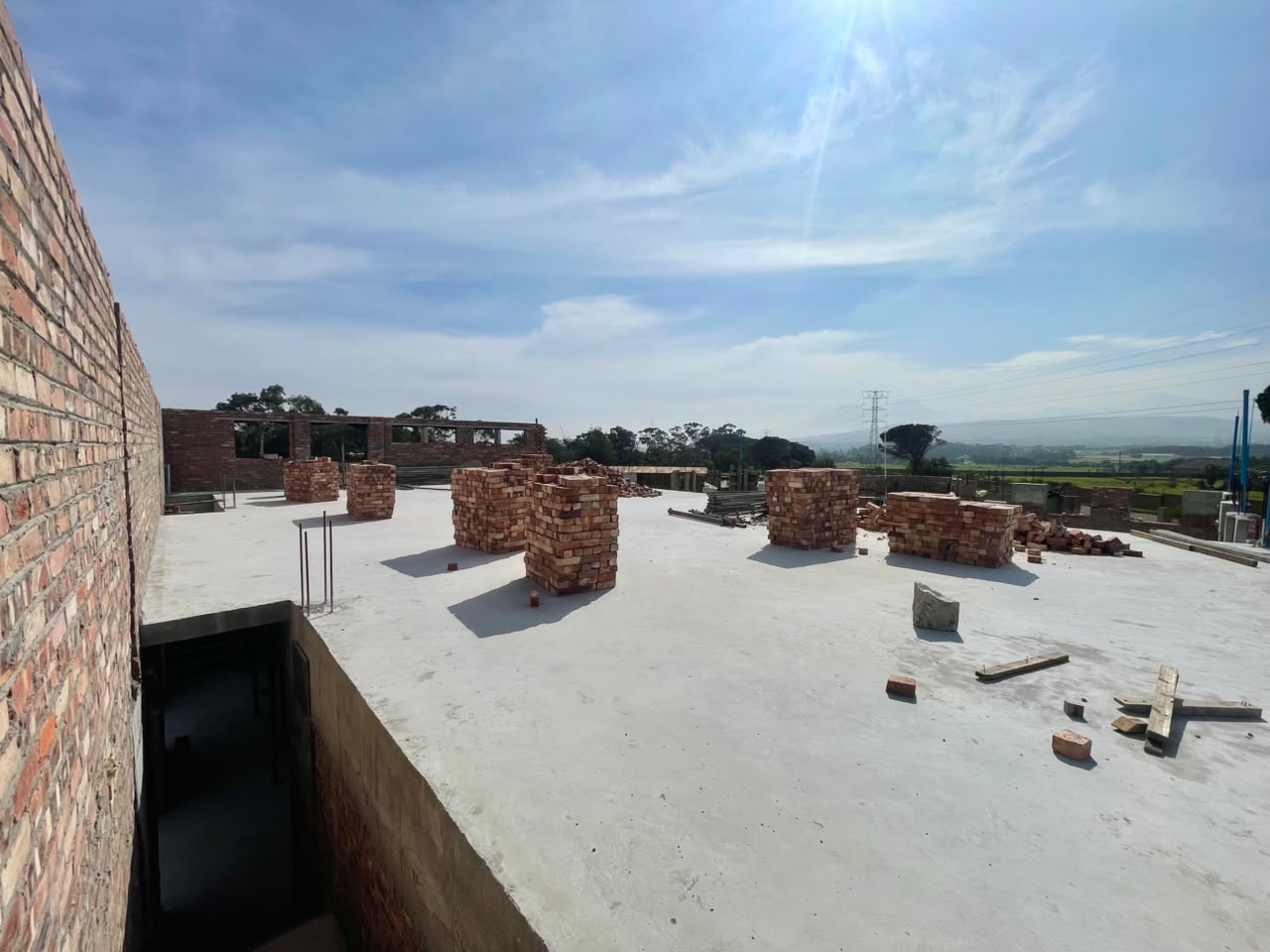

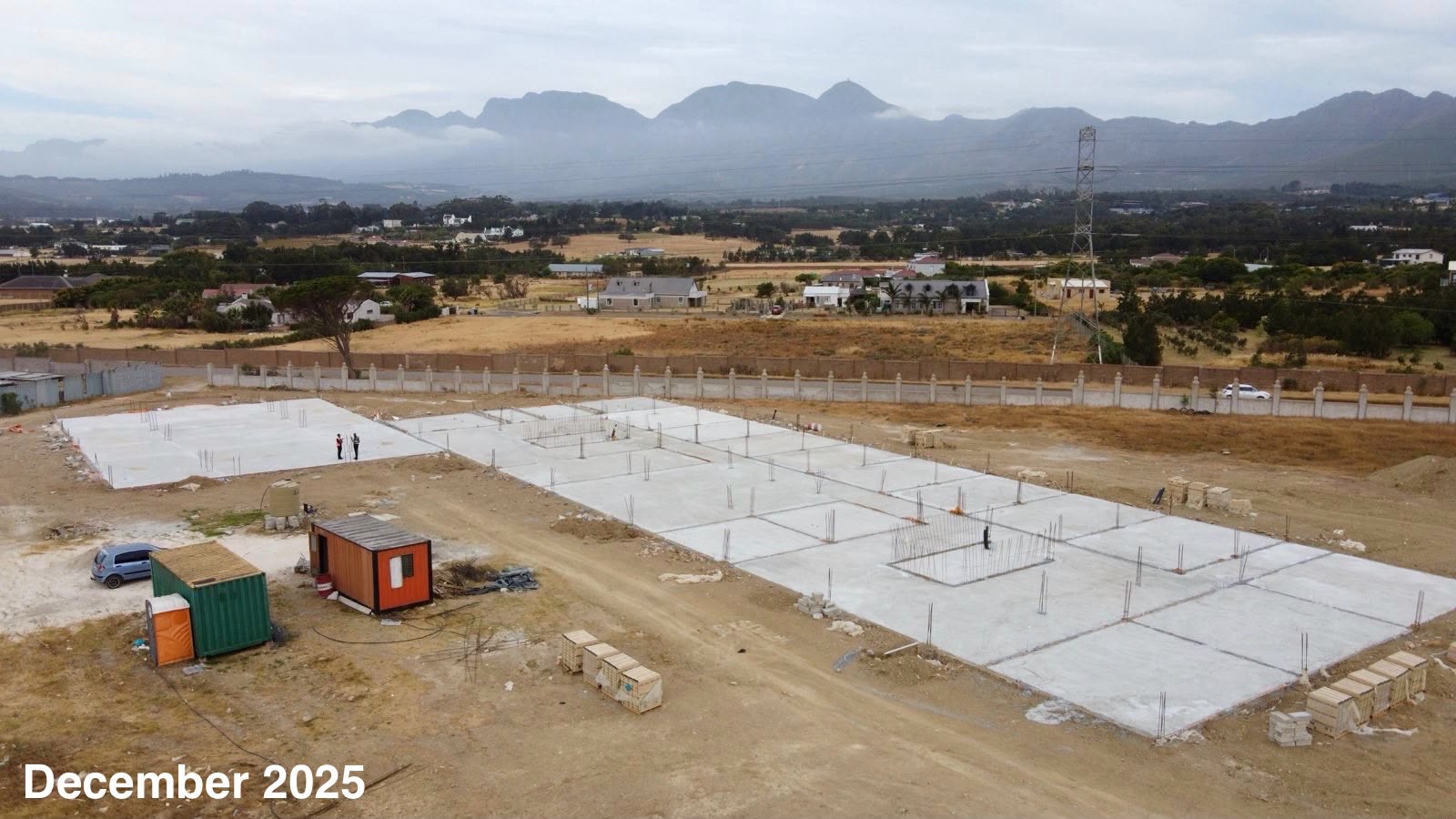

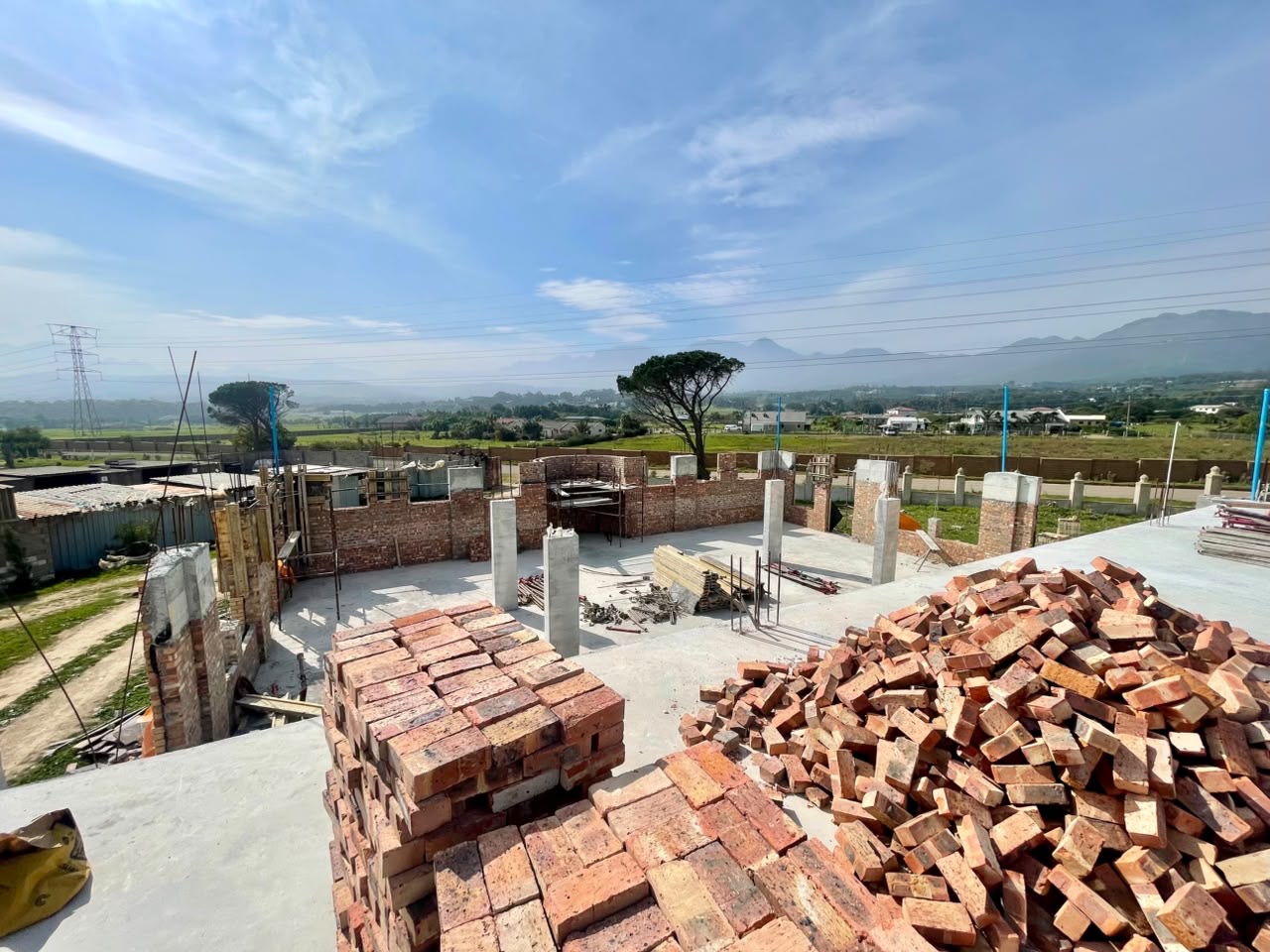

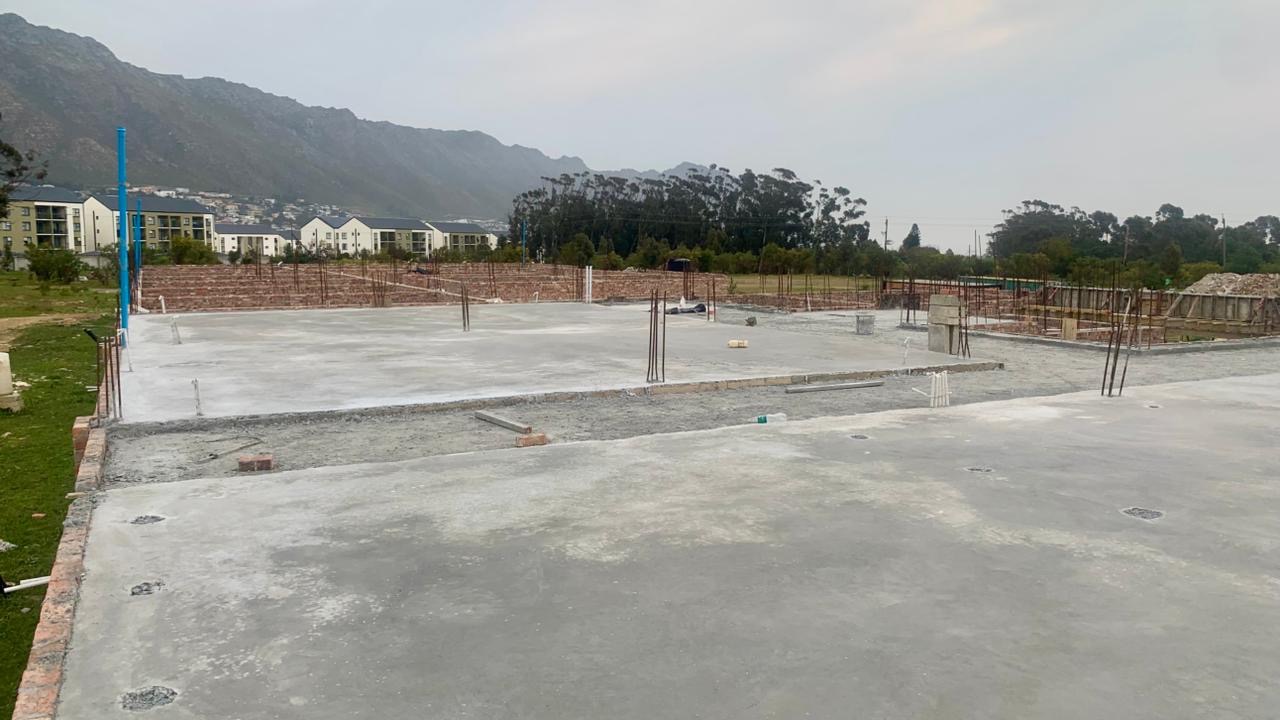

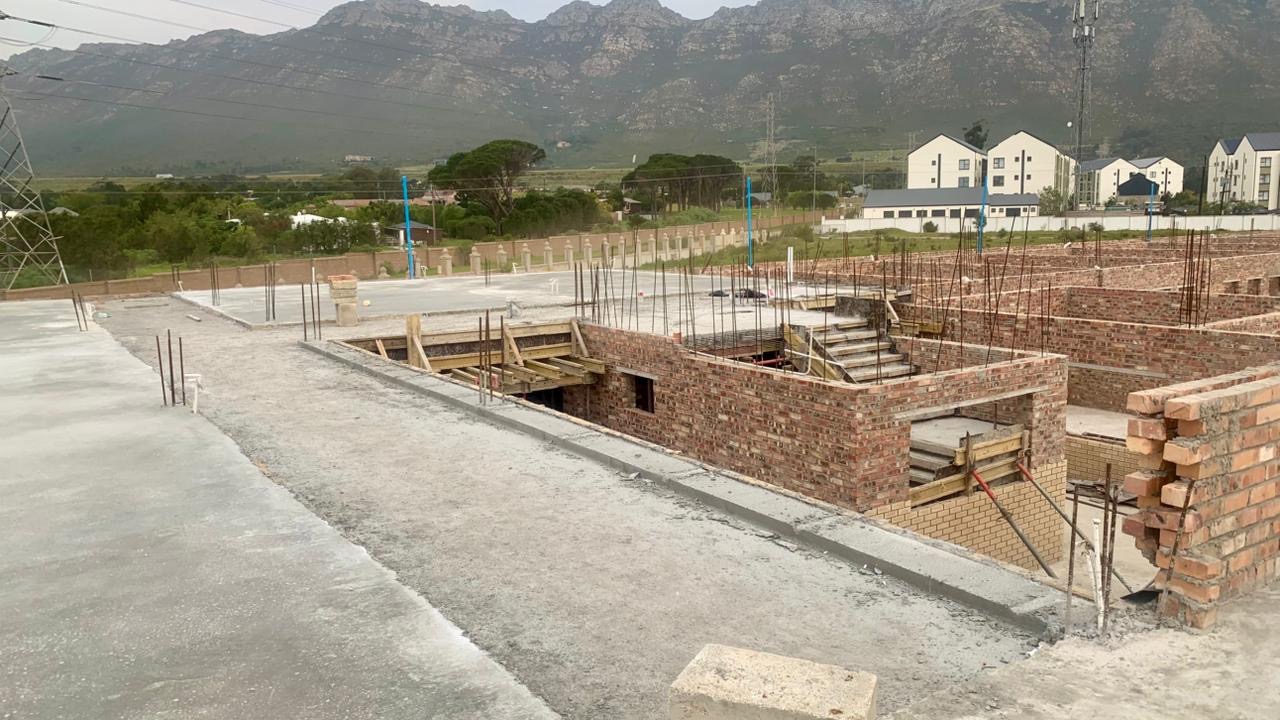

We have now progressed to Phase 2, which comprises the construction of the East Wing of the School Building and will be able to accommodate our current student body. We have also broken ground on the Masjid (Phase 3). We have cleared the site, excavated and smoothed the foundation trenches, poured the concrete for the foundations, built the foundation walls to ground floor level, filled the cavity walls and columns with concrete, backfilled the trenches, and compacted the ground for both Phase 2 and Phase 3. We have also purchased 120,000 face bricks and 28,000 clay bricks for the external envelope.
Work In Progress

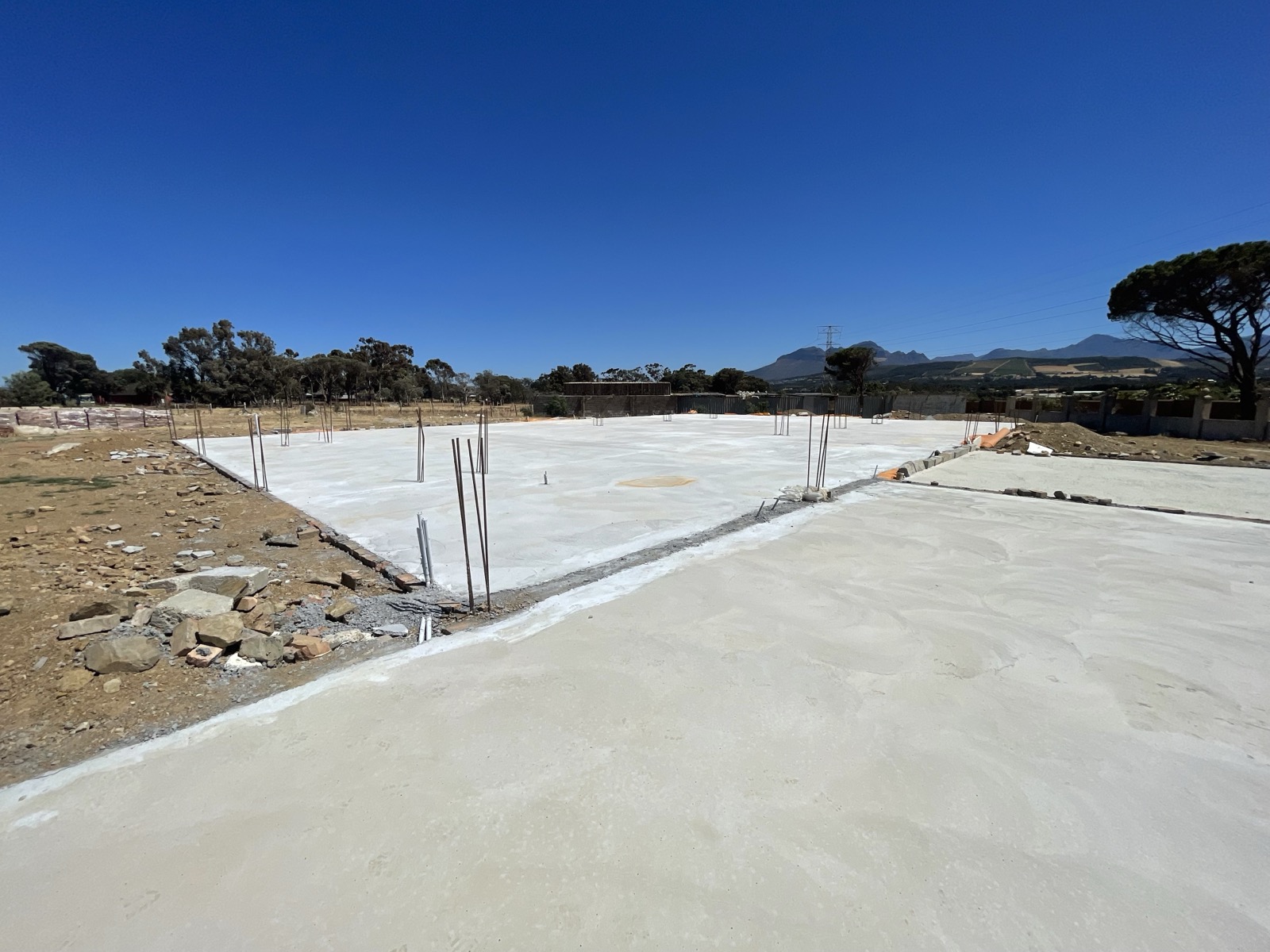

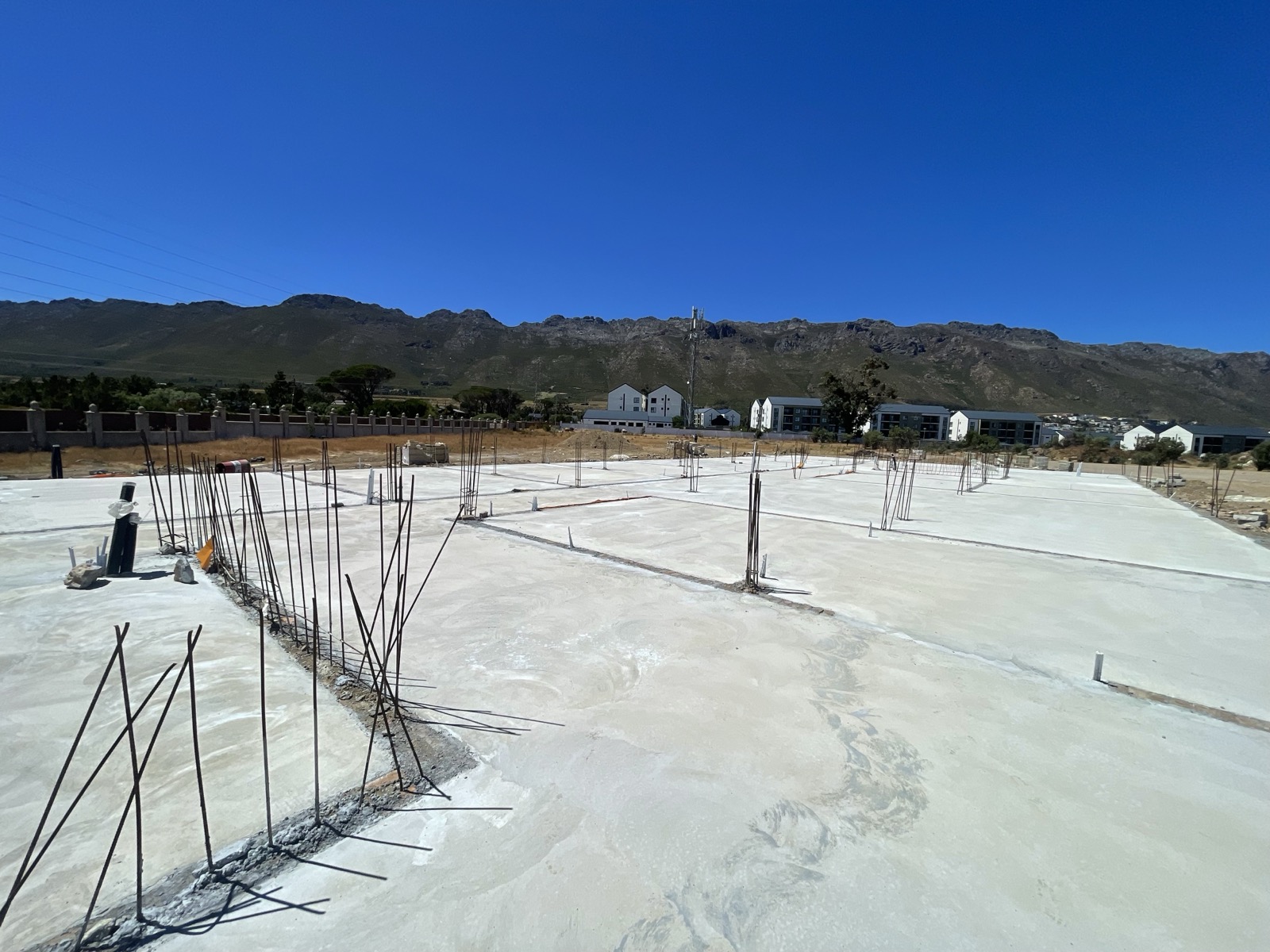

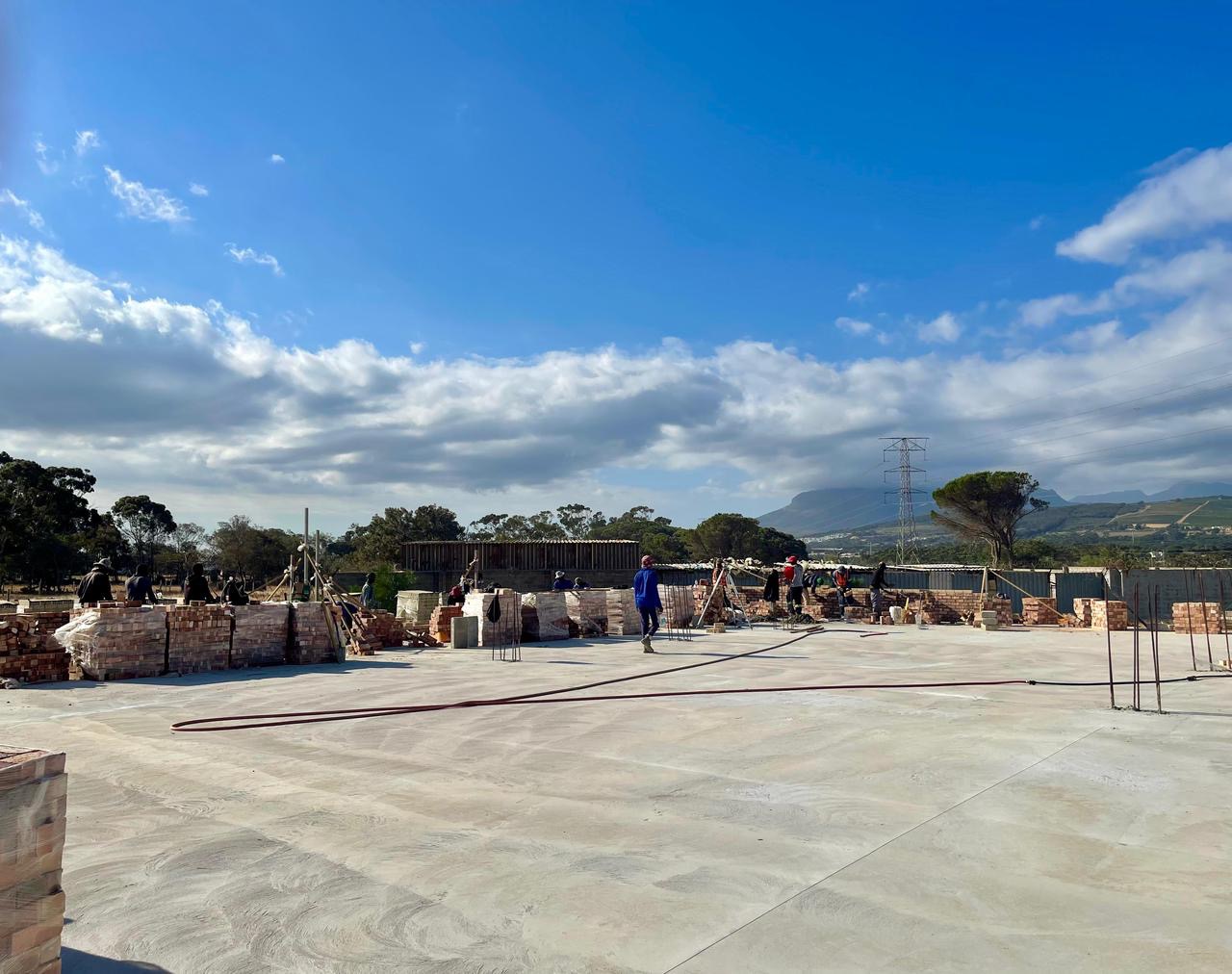

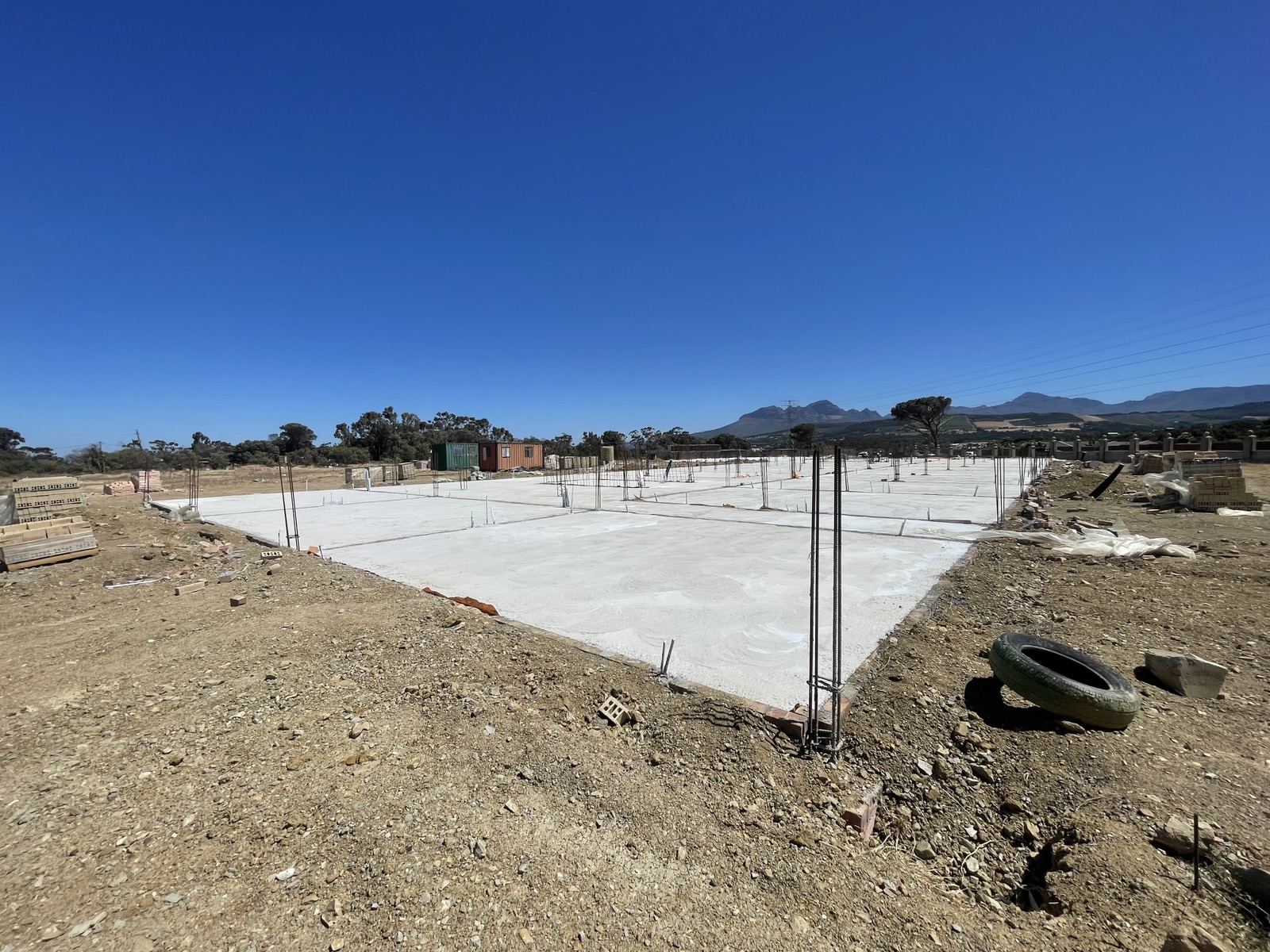

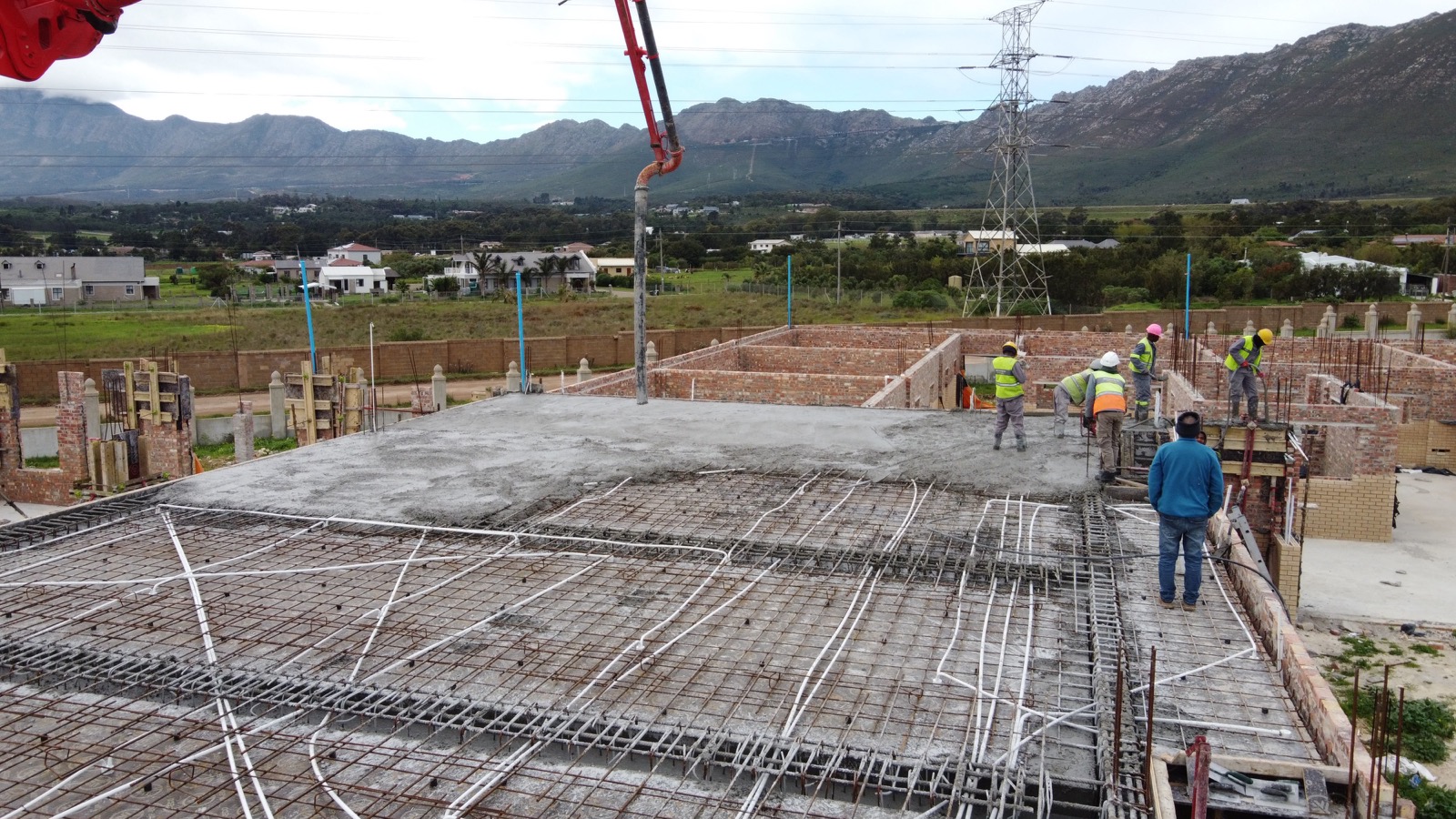

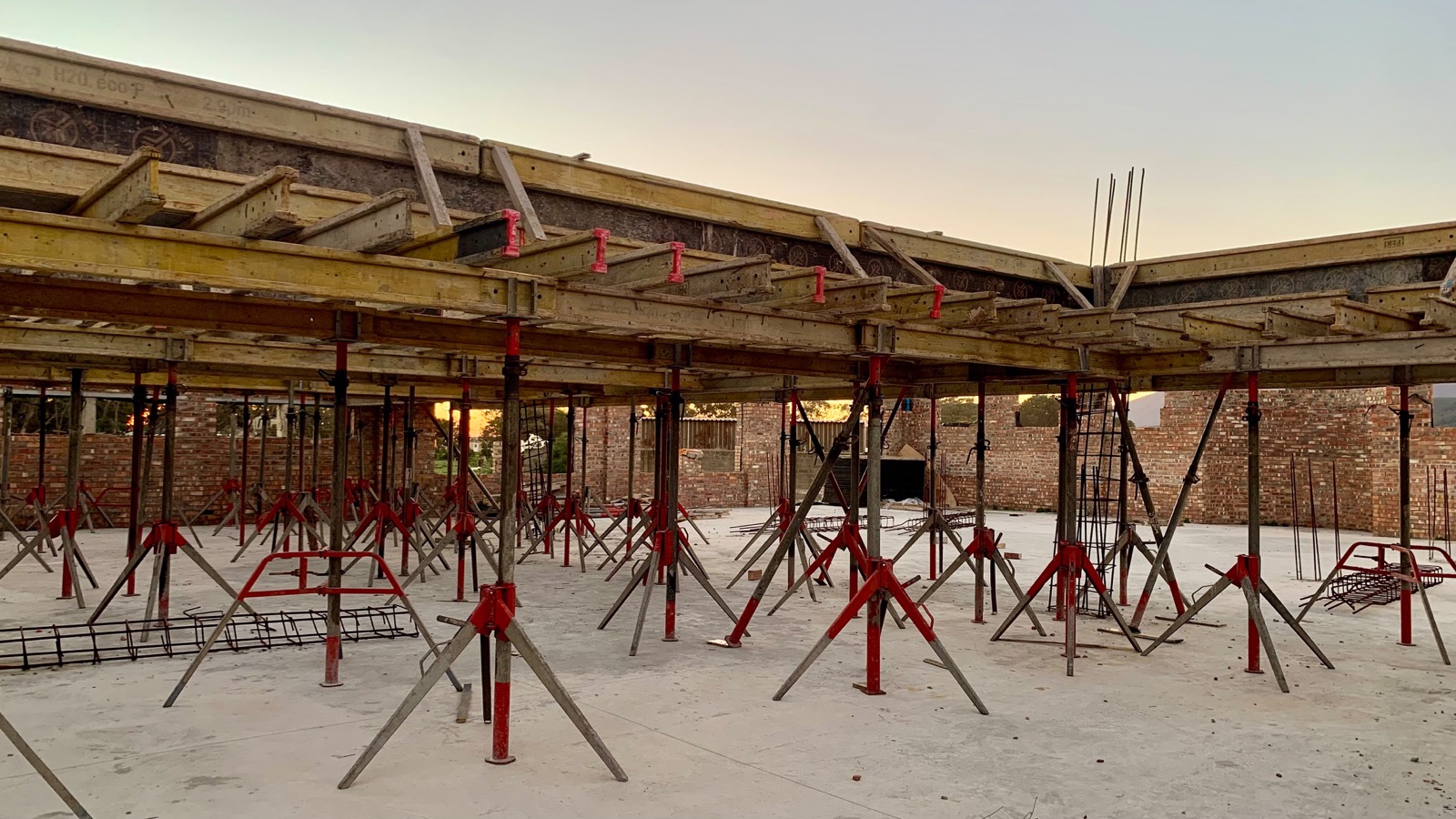

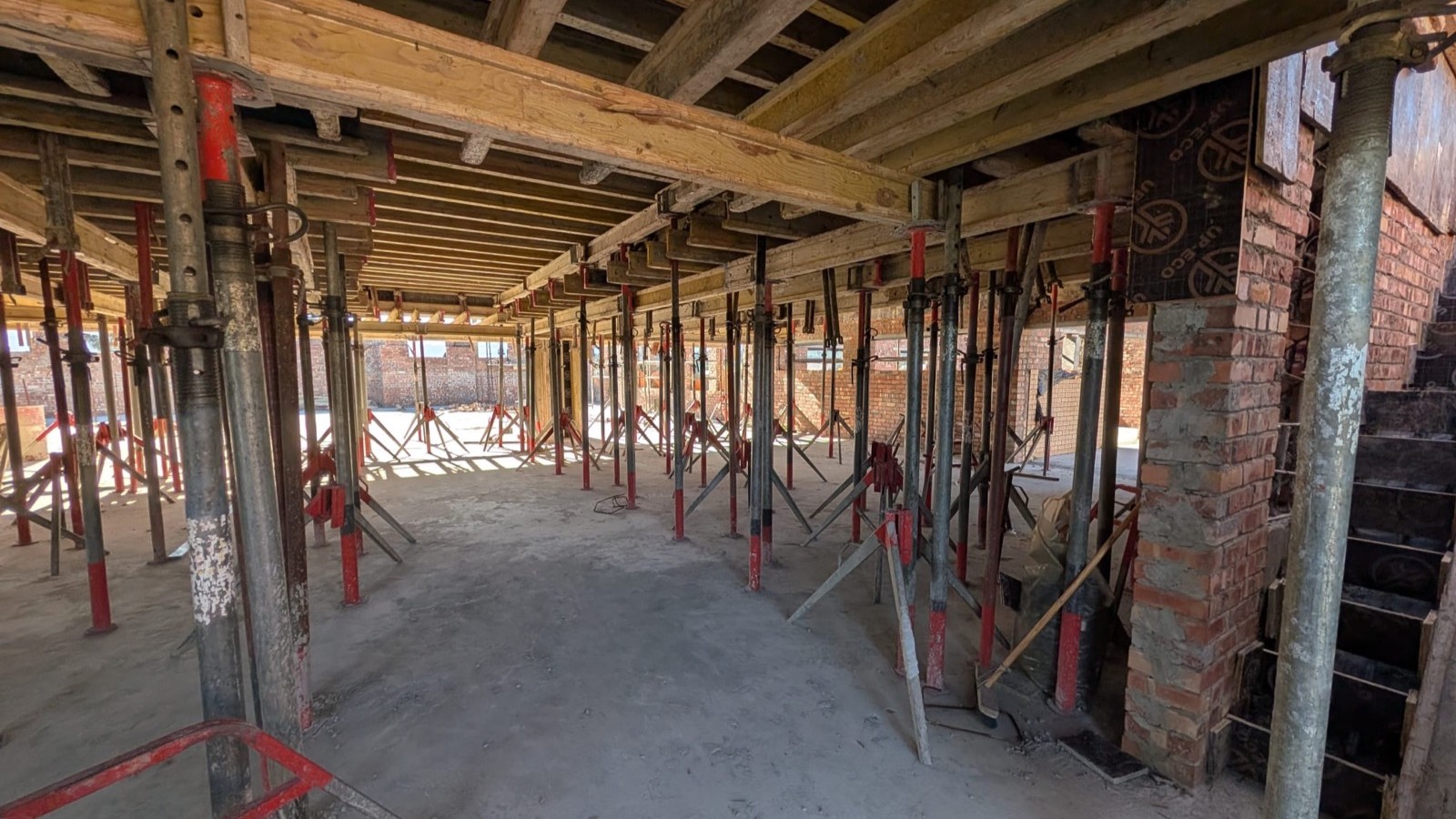

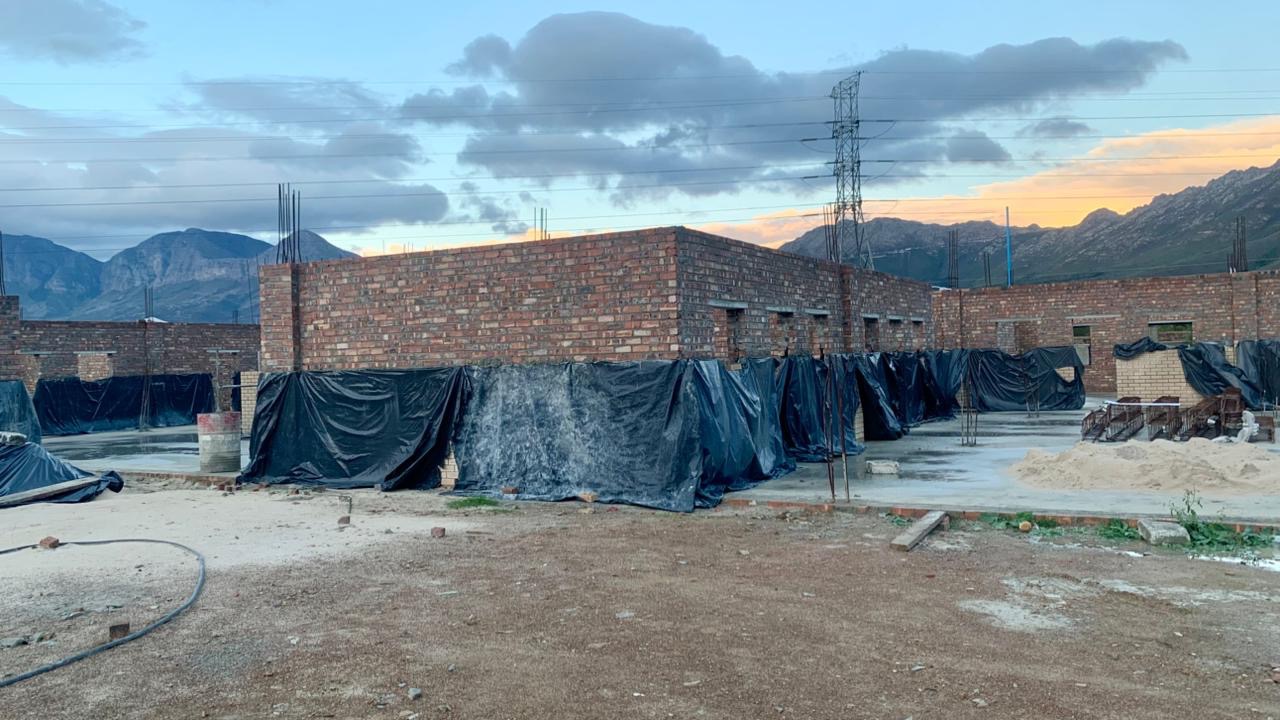

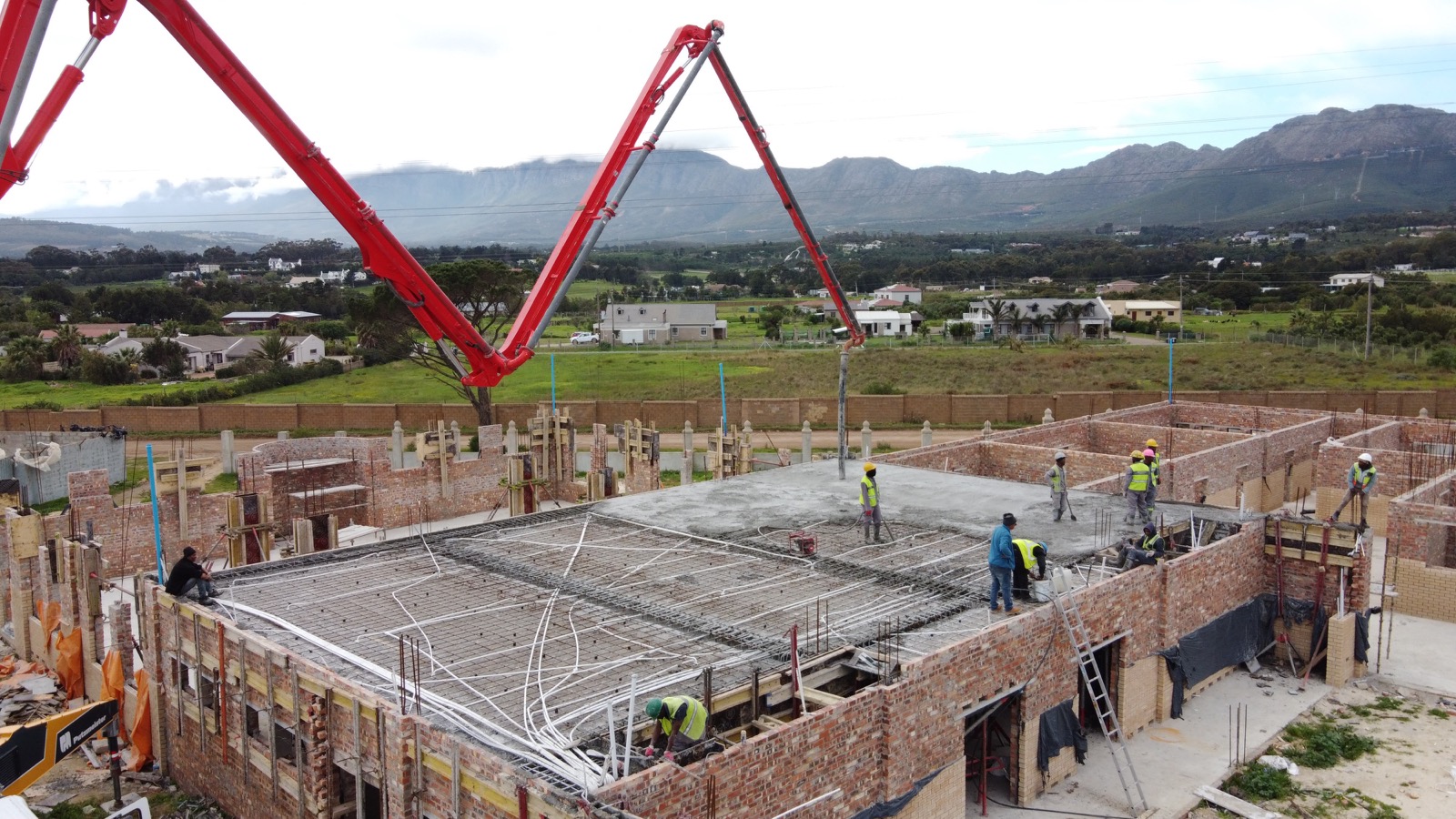

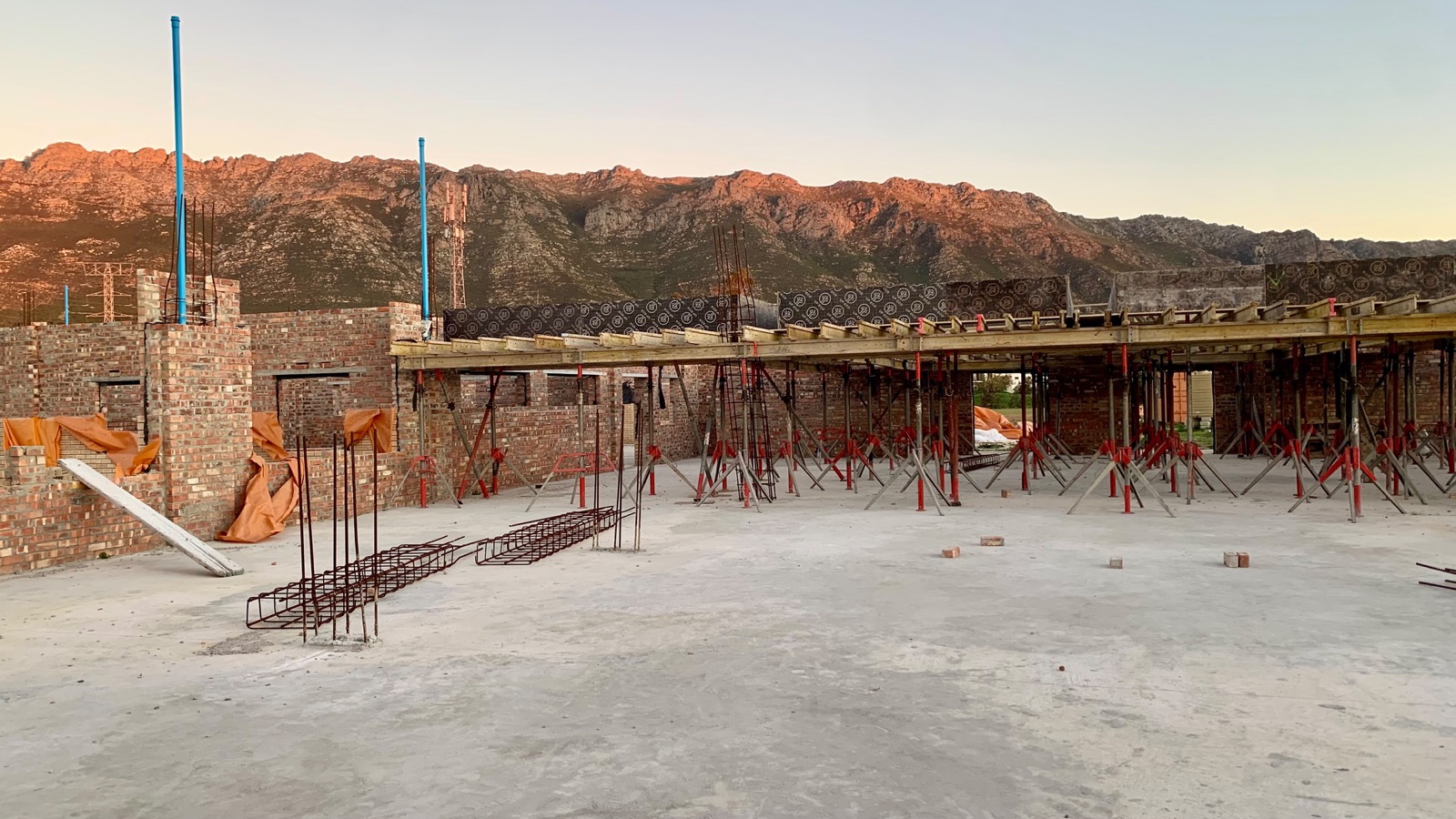

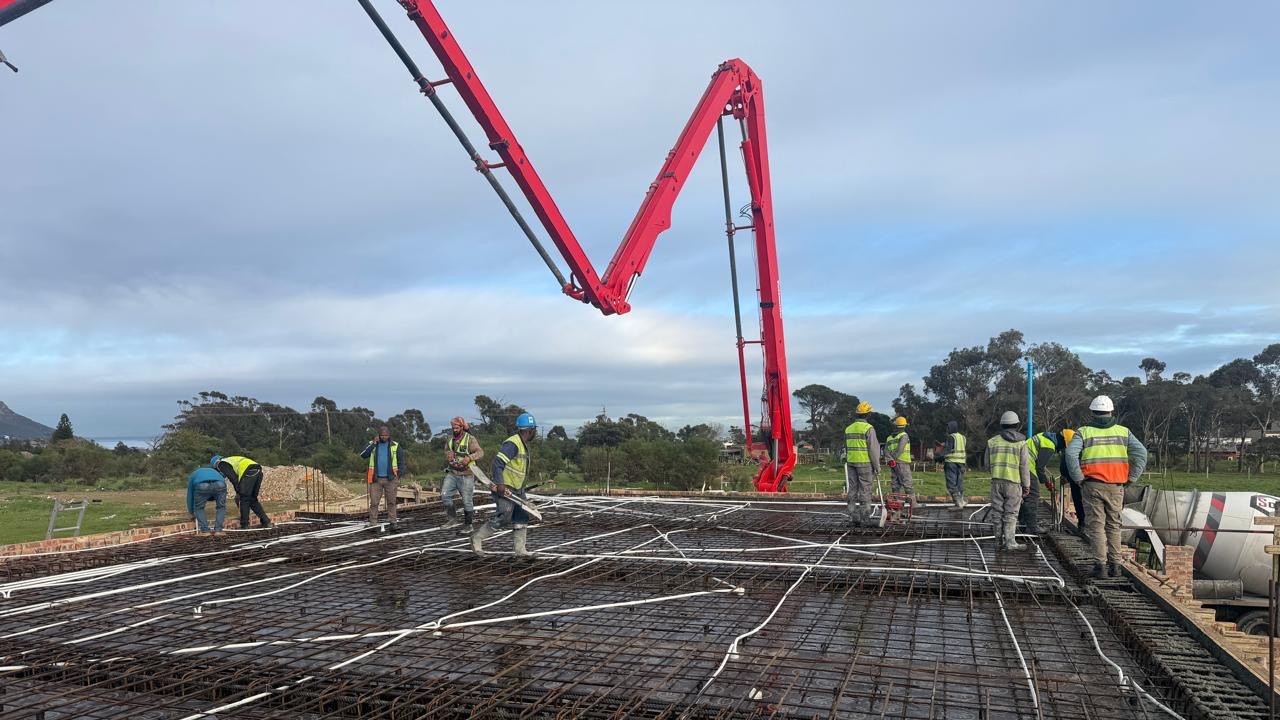

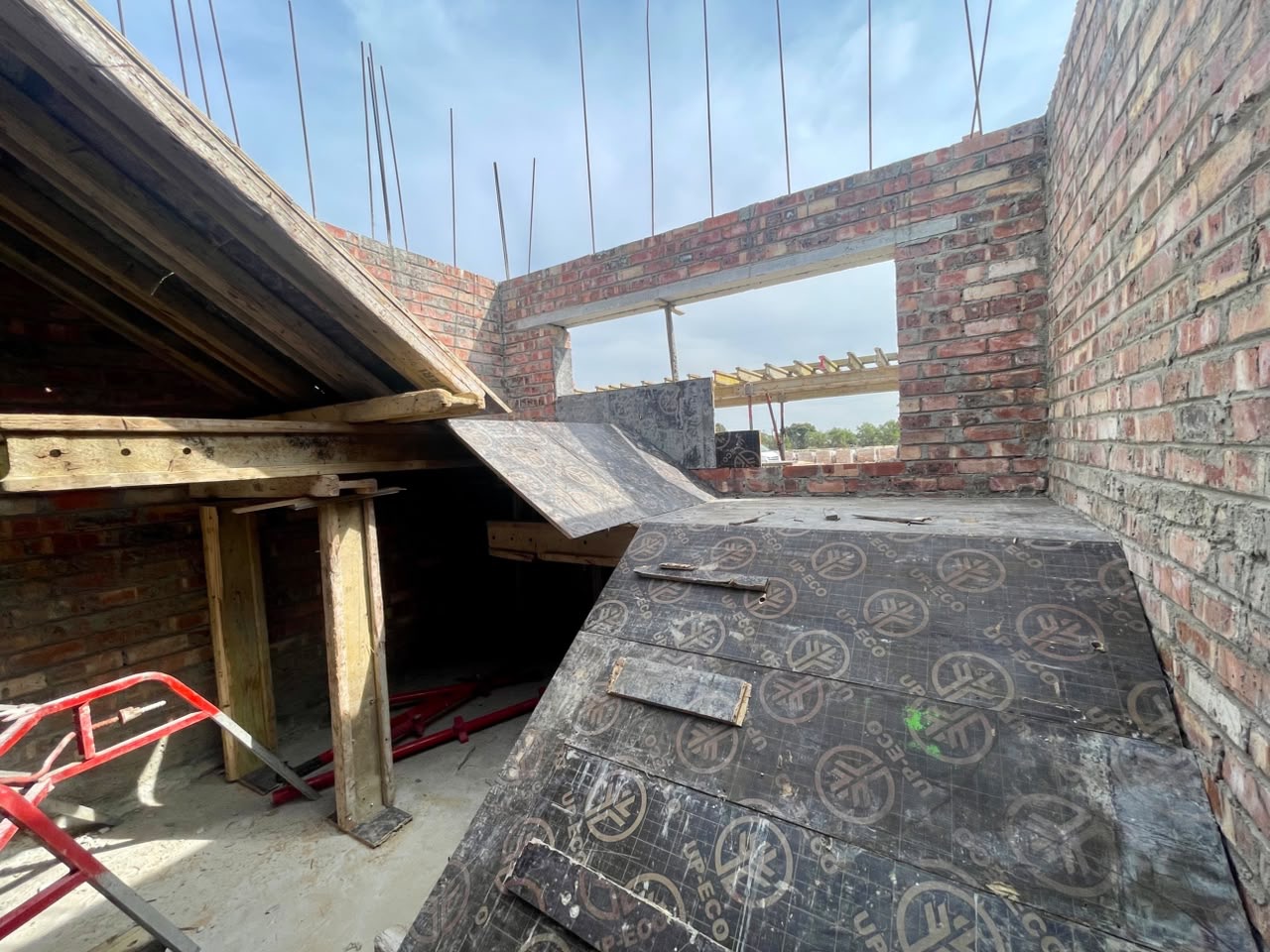

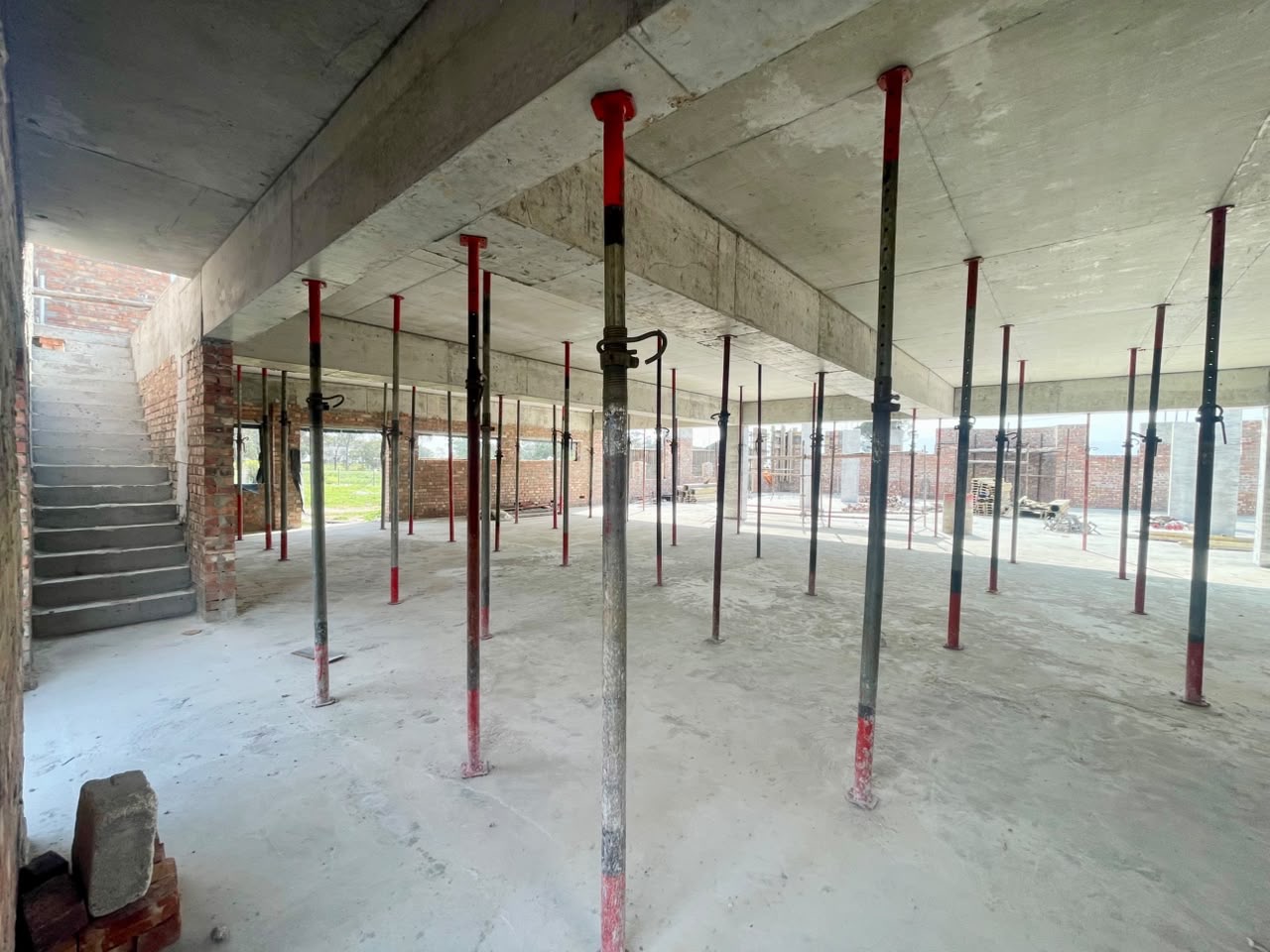

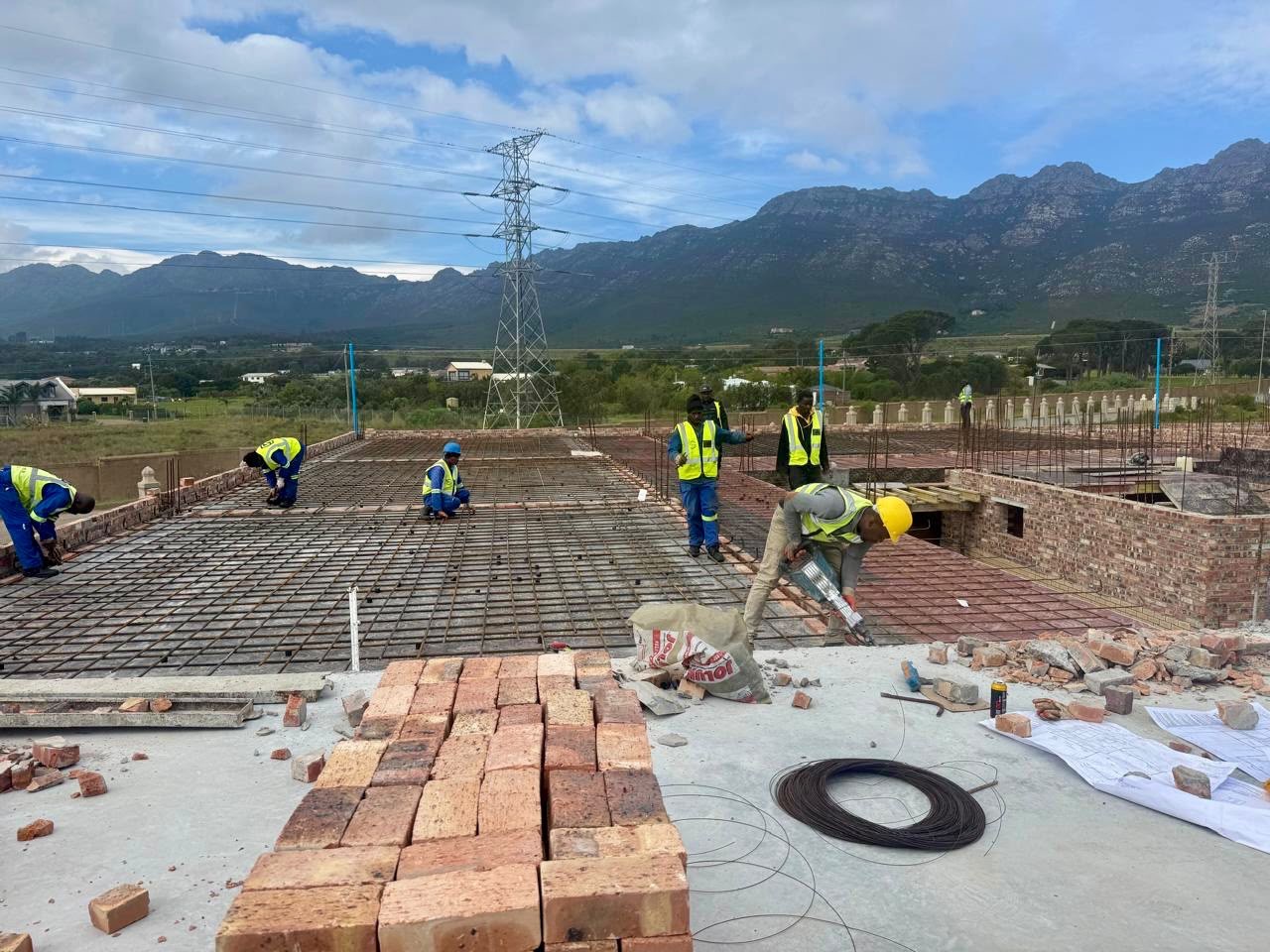

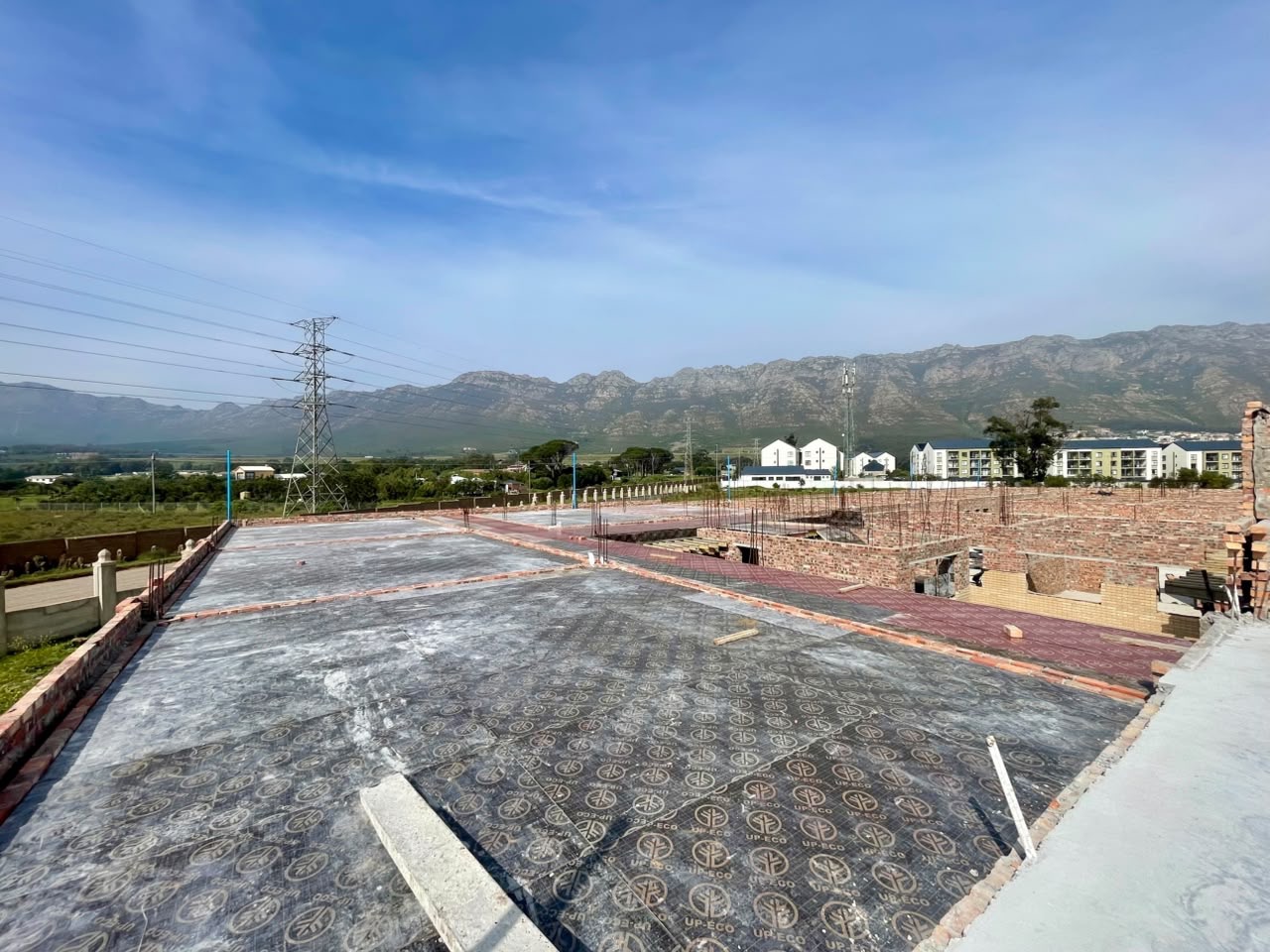

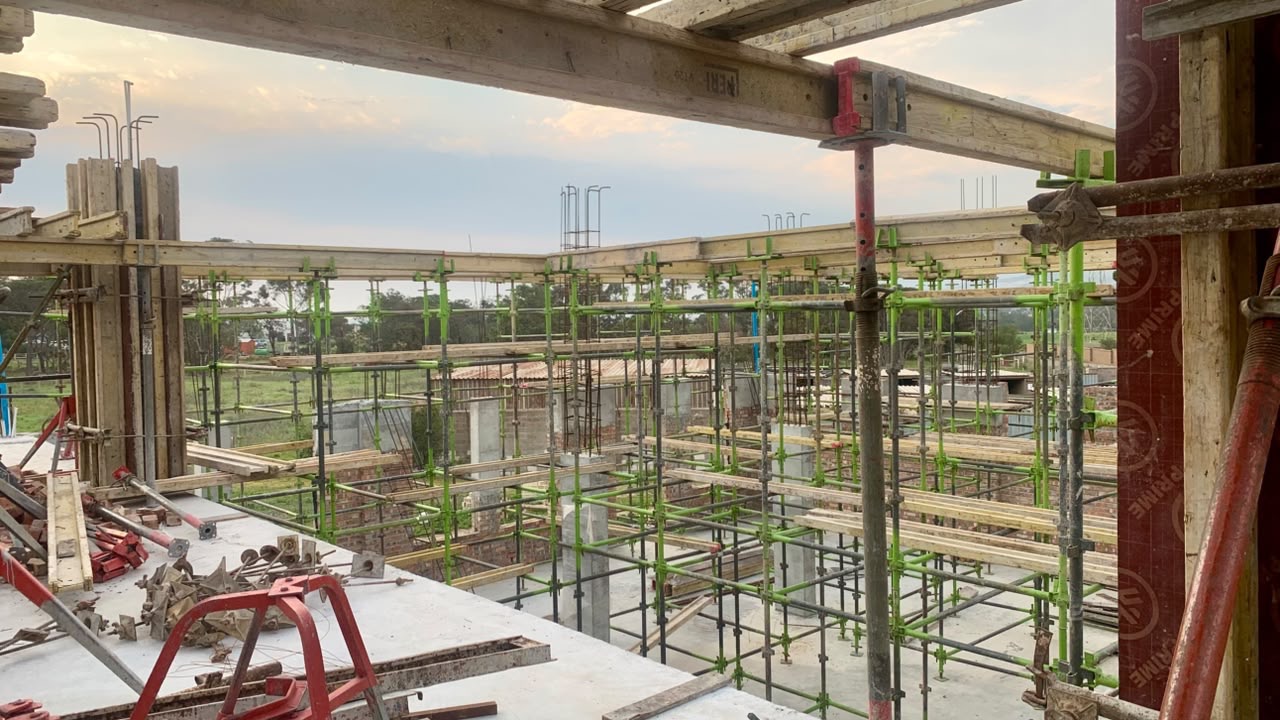

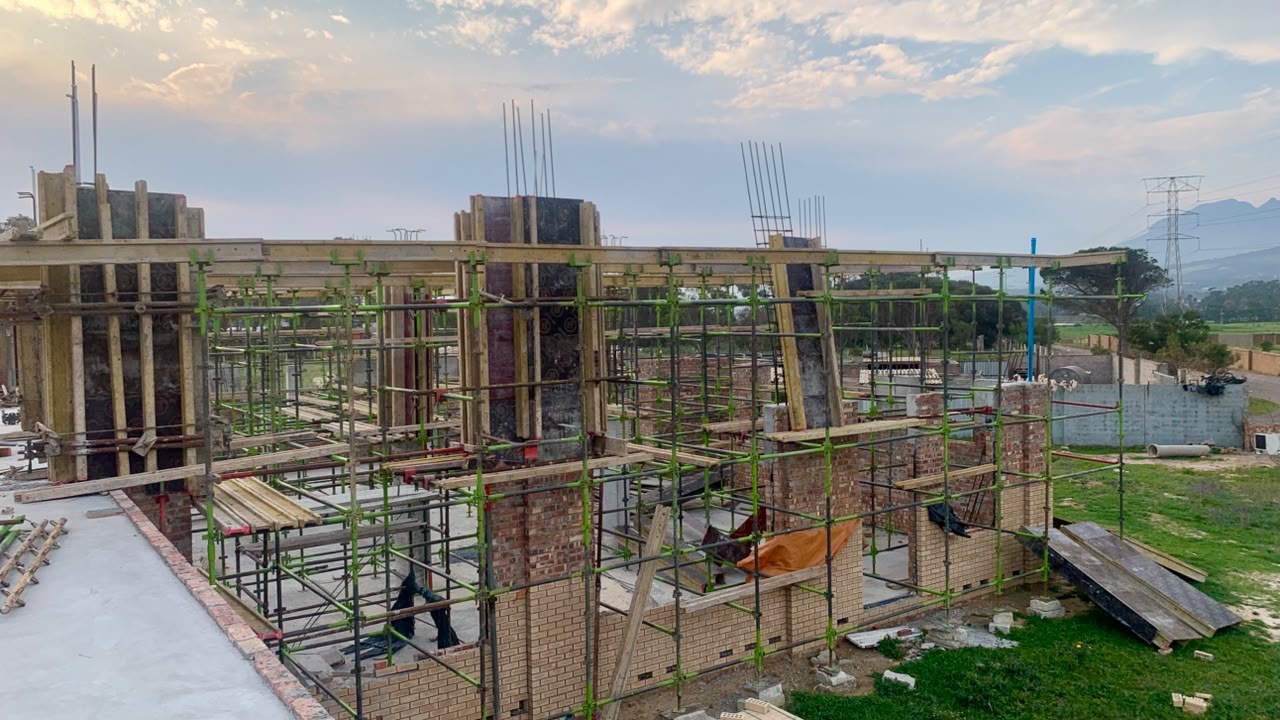

The waterproofing underlay, insulation, steel reinforcement, and electrical and plumbing conduits are currently being installed in preparation for casting of the ground floor slab for both Phase 2 and Phase 3, which is planned for 8 December.
This is an ideal opportunity to establish a Ṣadaqah Jāriyah (continuous charity) on behalf of yourself or your loved ones (both alive and deceased). May Allah SWT accept all our efforts, Āmīn.
